KNX ASSOCIATION CERTIFIED SINCE 2014

Malaysia's deepest KNX project record

524 systems since 2014, and 388 of them under RM100,000. Specification to witnessed commissioning, documented so anyone can take it over.

KNX engineer commissioning a labelled DIN-rail control panel with ETS software on a high-rise plant floor in Kuala Lumpur

Commissioning is where a KNX system is won or lost.

Bus voltage, loading and telegram traffic verified under load before anything is signed.

Experience measured the only honest way: projects finished

Anyone can quote a KNX system. Far fewer have taken one from a blank specification through panel build, commissioning and a handover that a building team could still run five years later. This is the record.

Every system is retained as a backed-up ETS project. If we disappeared tomorrow, any certified integrator in the world could pick your building up from our documentation. That is the point of an open standard, and it is the promise the portfolio below is built on.

524+

Projects commissioned

Across 55 distinct project types since 2014.

12 yrs

Continuously on the bus

KNX Association certified since 2014, still hands-on daily.

34,000+

Devices programmed

Actuators, sensors, controllers and gateways addressed in ETS.

2,600+

Bus lines commissioned

Designed, loaded, segmented and load-tested to KNX topology rules.

100%

ETS projects retained

Every system backed up and handed over. No black boxes, ever.

24

Manufacturers deployed

Specified on merit and price, never on a distribution agreement.

Portfolio record as at August 2026. Scope-level references are available on request under NDA where clients permit.

Our home ground

Nobody in Malaysia has delivered more KNX under RM100,000

This is not a discount claim. It is a depth claim. Three hundred and eighty-eight of the systems on our record were contracted below RM100,000 - condominiums, terrace houses, bungalows, shoplot fit-outs, clinics, halls and small commercial floors - and we have spent twelve years turning that band into an engineering discipline rather than a favour we do between the big jobs.

Most integrators treat a sub-RM100,000 KNX enquiry as a rounding error. We built the practice around it, and the discipline that forced on us is what the larger projects now run on. The method below does not change, whether the contract is RM16,900 or RM1.6 million.

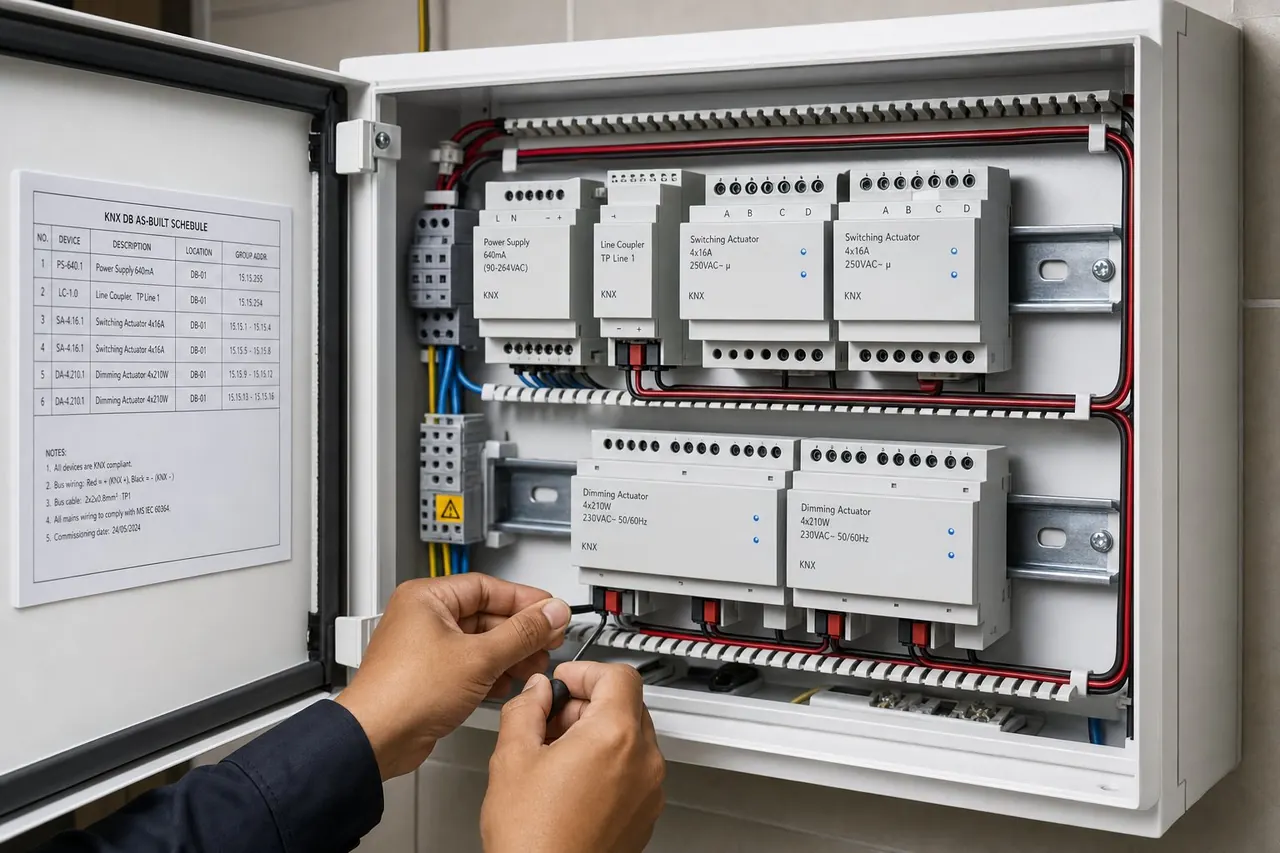

Compact labelled KNX DIN-rail control panel built to full standard in a Malaysian terrace house on a sub-RM100,000 project

A RM24,600 house. The same panel discipline as a RM2 million tower.

Segregated bus, labelled both ends, power supply sized with margin, as-built clipped inside the door.

388

Projects under RM100,000

74% of everything commissioned since 2014 was delivered inside this band.

RM38,400

Median contract value

Half the band lands below this figure. It is our normal day, not our exception.

RM14,888

Entry package

The smallest complete system we will sign. Same standard as the largest.

9 days

Median time on site

First fix to witnessed handover for a typical home in the band.

0

Documents dropped

No budget gets a lighter handover pack. As-built, ETS file and test sheet, always.

43%

Came back to extend

Owners who added zones or functions within three years, on the same bus.

Figures cover contracted project value excluding client-supplied luminaires and third-party equipment, as at August 2026.

Why this band is so badly served

A KNX project below RM100,000 needs the same design, programming and commissioning process as one ten times the size. Only the device count is smaller. That single fact explains almost everything a Malaysian homeowner experiences when they ask for a quotation.

What usually happens to the enquiry

The enquiry is quietly declined

A RM50,000 KNX job carries the same design, programming and commissioning overhead as a RM500,000 one. Most integrators price that overhead as a fixed cost, the number looks absurd, and they stop returning the call.

The quotation is padded to make it worth doing

The scope stays small and the price does not. You are paying for an engineering process that was never streamlined for a project your size.

You are steered off KNX entirely

“KNX is overkill for your house, take these Wi-Fi switches instead.” Three years later the app is discontinued, the vendor pivoted, and the switches are landfill in a wall you already closed up.

Or you get KNX hardware with none of the KNX engineering

Certified devices, cabled and programmed by someone learning on your building. No topology calculation, no labelling, no ETS file handed over. It works on day one, and it is unfixable on day four hundred.

What we do instead

The overhead was engineered out, not the system

Twelve years in this band produced a kit of parts: standard panel blocks, a fixed group-address schema, tested logic modules and a device shortlist we know the lead time on. Design hours fall. Engineering does not.

The price is fixed before we order anything

A paid survey produces a scoped, written, fixed-price proposal with the points list attached. Variations only happen when you change the scope, in writing, with the cost stated first.

One crew, no learning on your building

The same trained install team, the same engineer doing the ETS work. Your RM22,000 terrace house gets the person who commissions the towers, not the person who is being trained on it.

It is designed to grow, so it does not need to be big

We size topology and containment for what the building might become, then fit what you can afford now. Adding a floor, a zone or a gate later is a device and a download, never a rewire.

Six things that make a small KNX project work

None of them touch the engineering. Every one of them removes cost that a client should never have been asked to carry in the first place.

A kit of pre-engineered parts

Panel blocks, DIN layouts, terminal schemes and containment details already drawn and proven. We configure a known assembly instead of drawing a small project from a blank page.

One group-address schema, always

The same structured addressing standard on every project in the band. Any engineer of ours can open any of these systems and be productive in ten minutes, which is exactly why support stays cheap.

A reusable logic library

Presence release, staircase timers, tropical AC set-back, rain-retract on blinds, holiday presence simulation. Written once, tested hard, reused. You are not paying for logic to be invented again.

A short, stocked device list

A deliberately narrow shortlist of certified devices we hold or can get in days, chosen on price and availability across 24 manufacturers. No six-week import wait priced into your job.

One accountable engineer, start to finish

No sales handover, no coordination layer, no subcontracted programming. The person who surveys the building is the person who signs the commissioning sheet.

Fixed scope, fixed price, written

Points list, device schedule and price agreed before procurement. Small budgets die from variation orders, so we take variations off the table before the first cable is pulled.

“A small budget is not permission to engineer badly. It is a constraint, and constraints are the job. Tell me the ceiling first and I will tell you honestly what fits under it - including, sometimes, that it does not.”

Peter Teh, lead KNX integrator
Peter Teh
TEH HON KEE · LEAD INTEGRATOR

What each budget actually buys

Four rungs inside the band, with the device counts and site time we genuinely see. Written so you can find your own building before you speak to anyone. Every figure is indicative and every scope is surveyed and quoted in writing before anything is ordered.

Condominium or serviced apartment, single unit KNX installation in Malaysia at RM15,000 - RM24,000
ENTRY

RM15,000 - RM24,000

Condominium or serviced apartment, single unit

The essentials done to full standard: the lights, the air-conditioning and one set of blinds behave on their own, and the plates are the only thing you ever have to look at.

  • 8 to 12 lighting circuits, switched and dimmed
  • 2 to 3 air-conditioning zones via gateway
  • One motorised blind or curtain track
  • 4 to 6 wall plates, scene programmed
  • App access on local network plus remote
  • Full as-built pack, ETS file and test sheet

DEVICES

9 to 16

BUS LINES

1

SITE TIME

3 to 7 days

GROWTH

Sized for a second area later

Link, terrace or townhouse, whole home KNX installation in Malaysia at RM24,000 - RM45,000
MOST COMMON

RM24,000 - RM45,000

Link, terrace or townhouse, whole home

The band we deliver more of than anything else. A whole double-storey home, every level, with the gate and the alarm brought onto the same bus so one plate at the door means everything.

  • 18 to 30 lighting circuits across two or three levels
  • 4 to 5 air-conditioning zones with occupancy set-back
  • Auto-gate, main door and alarm integration
  • Motorised curtains to the living and master areas
  • Whole-home scenes: morning, away, night, holiday
  • Full as-built pack, ETS file and test sheet

DEVICES

22 to 38

BUS LINES

1 to 2

SITE TIME

2 to 3 weeks

GROWTH

Riser and spare ways for a third level

Semi-D, bungalow, shoplot fit-out or an office suite KNX installation in Malaysia at RM45,000 - RM70,000
LARGE HOME / SMALL COMMERCIAL

RM45,000 - RM70,000

Semi-D, bungalow, shoplot fit-out or an office suite

Where zoning starts to earn its keep. Multiple floors or multiple trading modes, energy measured rather than guessed, and a system somebody other than the owner has to operate.

  • 35 to 60 circuits, multi-zone and multi-level
  • Full climate control with per-zone scheduling
  • Shading with wind and rain safety logic
  • Energy metering on the main incomers
  • Operating modes for staff, not just for a family
  • Operator training and a quick-reference card

DEVICES

45 to 80

BUS LINES

2 to 3

SITE TIME

3 to 5 weeks

GROWTH

Coupler and spare capacity per line

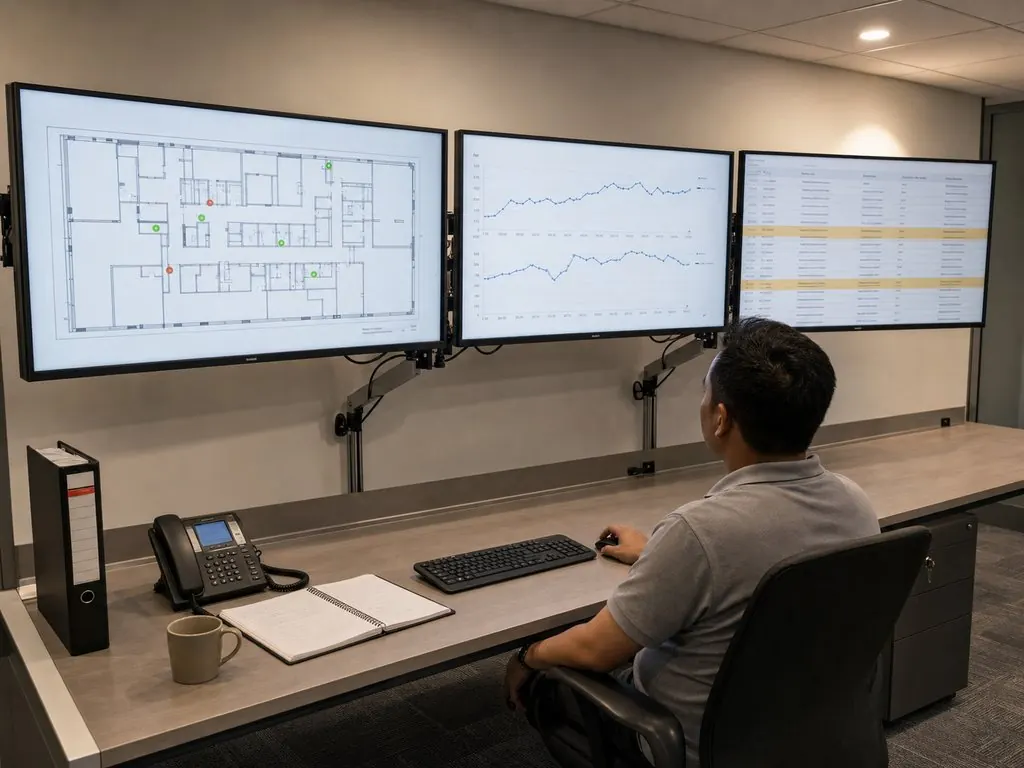

Boutique office floor, clinic, community hall, condo common areas KNX installation in Malaysia at RM70,000 - RM100,000
SMALL BUILDING

RM70,000 - RM100,000

Boutique office floor, clinic, community hall, condo common areas

A building, not a home. Several parties use it, somebody is accountable for the electricity bill, and the reporting has to hold up in a management meeting.

  • Zoned lighting with presence and daylight control
  • Central or VRF plant integration and scheduling
  • Sub-metering with allocation by zone or tenant
  • Scheduled access to doors and after-hours rules
  • Monthly exportable energy and occupancy reports
  • Handover pack written for a building team, not an owner

DEVICES

80 to 160

BUS LINES

3 to 5

SITE TIME

5 to 8 weeks

GROWTH

Backbone laid for the floors above

Below RM15,000 we will say no, and we will tell you why rather than take the job. Under that figure the fixed cost of surveying, programming, commissioning and documenting a system properly consumes the whole budget, and the only way to deliver it is to skip one of them. A single room does not need a bus. Come back when the scope is a floor.

Six projects, told properly

Values are the contracted figures. Names and exact addresses are withheld where clients have asked, which is most of the time. Everything else is as it happened, including the parts that were our idea and the parts that were not in the original brief.

The double-storey terrace that was quoted RM71,000 elsewhere - KNX project in Setia Alam, Selangor
RM24,600 Setia Alam, Selangor 11 days on site

The double-storey terrace that was quoted RM71,000 elsewhere

OWNER-OCCUPIER, RENOVATION

The owner came to us with two quotations. One was RM71,000 for a KNX system in a 22 by 75 terrace house. The other was RM9,800 for a bag of Wi-Fi switches and a hub. He had assumed the truth was somewhere in the middle and was mostly trying to work out which one was lying.

Neither was. The RM71,000 quotation had a proper device schedule attached and every line of it was defensible - it was simply drawn from a blank page by a firm whose smallest normal job is a hotel. The design hours alone accounted for more than a third of it. We priced the same house at RM24,600 by starting from a panel block and an addressing schema we had already built and tested ninety times, and by cutting the device count where the function was duplicated rather than where the engineering was.

What actually came out: sixteen dimmed circuits reduced to eleven where two switches were controlling the same visual effect, and a third-floor allowance deleted because there is no third floor. What did not come out: the line was loaded to 60% of capacity, the power supply sized with margin, both ends of every cable labelled, and the handover pack issued in full. Two years later he added the porch and the water feature. That cost him a device and a download.

Circuits
11 dimmed, 9 switched
AC zones
4, with set-back
Integrated
Auto-gate, alarm, main door
Extended since
Yes, twice
A 1,050 sq ft condominium, three days, no wall hacking - KNX project in Mont Kiara, Kuala Lumpur
RM16,900 Mont Kiara, Kuala Lumpur 3 days on site

A 1,050 sq ft condominium, three days, no wall hacking

OWNER-OCCUPIER, OCCUPIED UNIT

An occupied unit with a finished ceiling and a wife who had made it very clear that nobody was cutting the plaster. The requirement was modest and specific: stop leaving the air-conditioning running in an empty bedroom, stop the living room being either fully bright or fully dark, and be able to check the whole unit from the airport.

Wired KNX was out on the ceiling side, so the installation is a hybrid: twisted-pair bus run inside the existing switch loops and the DB where the containment already existed, and KNX RF for the two bedroom points where it did not. Ten circuits, three air-conditioning zones on IR gateways, one blind, five plates. The whole job was surveyed on a Saturday, cabled and programmed across three weekdays, and commissioned before the weekend.

The point of the story is not that it was cheap. It is that a RM16,900 system in a rented-out-later condominium still left the owner holding an ETS project file, a labelled DB, a device inventory with warranty dates and a signed test sheet. When she sells that unit, the buyer inherits a system any certified integrator on earth can take over. That is worth considerably more than the difference between us and a hub in a cupboard.

Circuits
10
AC zones
3 via IR gateway
Method
Hybrid TP + KNX RF
Wall hacking
None
A shoplot café that had to keep trading through the whole install - KNX project in George Town, Penang
RM58,300 George Town, Penang 4 weeks, night works

A shoplot café that had to keep trading through the whole install

F&B OPERATOR, GROUND FLOOR PLUS STUDIO ABOVE

A conservation-area shoplot: café on the ground floor, a small studio let above, and an operator who could not afford to close for a single lunch service. The brief was ambience the staff could not get wrong, plus an end to the standing argument about who forgot to switch off the signage.

We worked nights and split the job into four releases, each one commissioned and tested before the next began, so the café opened every morning on a working system. Front of house runs four trading scenes on a single recessed plate - open, trade, dinner, close - with the close scene sequenced so the kitchen extract and the display cases drop out in a fixed order. Signage and façade lighting run on an astronomical clock, so nobody forgets anything again. The studio above is a separately metered zone with its own plate and its own tenant rules.

The energy metering was not in the original brief; we added it at RM3,400 because the operator could not tell us what the café cost to run. The first full month of data showed the display chillers holding a load through the closed hours that nobody had accounted for. That finding paid for the metering four times over in the first year, which is roughly the story of every energy meter we have ever installed.

Scenes
4 trading modes
Zones
Café, kitchen, façade, studio
Metering
Separate tenant sub-meter
Downtime
Zero trading days lost

An orphaned bungalow system, recovered instead of ripped out - KNX project in Johor Bahru, Johor
RM41,300 Johor Bahru, Johor 6 weeks, phased

An orphaned bungalow system, recovered instead of ripped out

SECOND OWNER, HOUSE BOUGHT WITH THE SYSTEM IN IT

The house was bought with a KNX system already in it and no file, no drawings, no passwords and no installer - the company had wound up. Half the ground floor no longer responded to anything. Two contractors had already quoted to strip it out and start again, at RM120,000 and RM145,000, which is what happens when nobody wants to take responsibility for somebody else's work.

We spent four days on the bus before quoting anything: reading device addresses off the live line, mapping what physically responded to what, opening every DB in the house and photographing it. Eighty-one of the ninety-four devices were healthy certified hardware. The dead zone turned out to be a failed power supply on an unsegmented second line that had been loaded well past sensible - the original fault was a design decision made years earlier, not a device.

The recovery came to RM41,300: a new supply, a line coupler and proper segmentation, thirteen device replacements, a rebuilt and fully documented ETS project, and re-labelling throughout. The owner kept RM79,000 of working hardware that two other firms had written off. He also, for the first time, owns the file.

Devices found
94 on the live bus
Retained
81
Root cause
Unsegmented, overloaded line
Now held
Full ETS project + as-built
A community hall the committee had to be able to run themselves - KNX project in Seremban, Negeri Sembilan
RM88,400 Seremban, Negeri Sembilan 7 weeks

A community hall the committee had to be able to run themselves

MANAGEMENT COMMITTEE, VOLUNTEER OPERATORS

A multipurpose hall and adjoining rooms, run by a volunteer committee that changes every two years. Every previous system in the building had failed the same way: it worked until the one person who understood it stopped being on the committee.

So the constraint drove the whole design. The hall has one plate at the entrance with four labelled modes and nothing else - the sound reinforcement, the fans, the lighting levels and the air-conditioning for each mode were argued out with the committee during design and then locked. There is no app requirement to operate the building. There is an app, and no volunteer is ever obliged to open it.

The RM88,400 covers the hall, two meeting rooms, the kitchen, external and car-park lighting on an astronomical clock, and sub-metering so the committee can see what an event actually costs to hold. The handover pack is written for someone with no technical background, and the annual maintenance visit is timed to land just after the committee changes over, so the new chairman meets us in his first month rather than during his first fault.

Operating modes
4, on one plate
Metered
Hall, kitchen, external
Training
Committee + caretaker
Support
Annual visit at handover of office

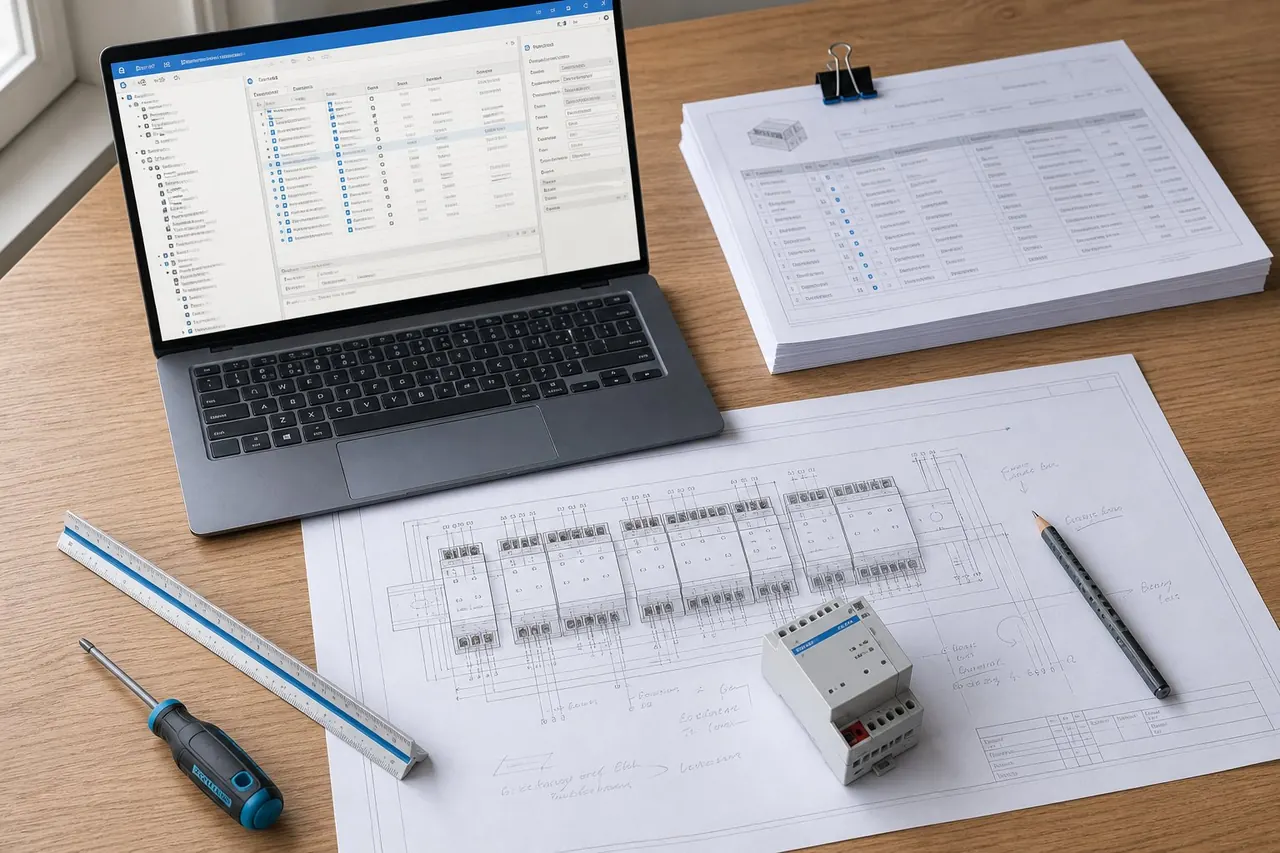

Eighteen units at a per-unit price a developer could put in a brochure - KNX project in Klang Valley
RM19,200 per unit Klang Valley One template, then 18 replications

Eighteen units at a per-unit price a developer could put in a brochure

BOUTIQUE DEVELOPER, LOW-DENSITY BLOCK

A small developer with eighteen units wanted a genuine automation story for the launch and had been told, correctly, that KNX would not work at his price point. It would not have, quoted the usual way: eighteen individually engineered units at typical design rates puts the per-unit figure somewhere no boutique project can absorb.

One unit was engineered, programmed, tested and signed off as the template - that unit carried the real cost. Every unit after it is a replication: its own ETS sub-project, its own serialised device schedule, its own test sheet, but no new design work. The per-unit price landed at RM19,200 and, more usefully for him, it was a number he could commit to in writing before the first slab.

The block was released in three groups of six to follow vacant possession. Each buyer received a per-unit handover pack, and the JMB received the block-level documentation and a maintenance proposal at handover of common property. This is the same method we use on towers. There is no minimum size at which it starts working.

Units
18, phased in 3 releases
Engineered
Once, as a type unit
Per unit
Own ETS sub-project + test sheet
JMB
Block documentation at handover

What a small budget never buys you out of

Every item below survives at RM15,000 exactly as it survives at RM1.5 million. If a quotation you are holding does not name these, it is not cheaper than ours. It is smaller than it appears.

How we take cost out instead
  • Topology margin. Lines loaded with spare capacity and segmented properly, whatever the device count.
  • Power-supply headroom. Sized with stated margin and calculated, never assumed because the job is small.
  • Labelling and containment. Both ends of every cable, every device, segregated from mains.
  • The ETS project, handed to you. Backed up offsite and yours. A ten-device system with no file is still a black box.

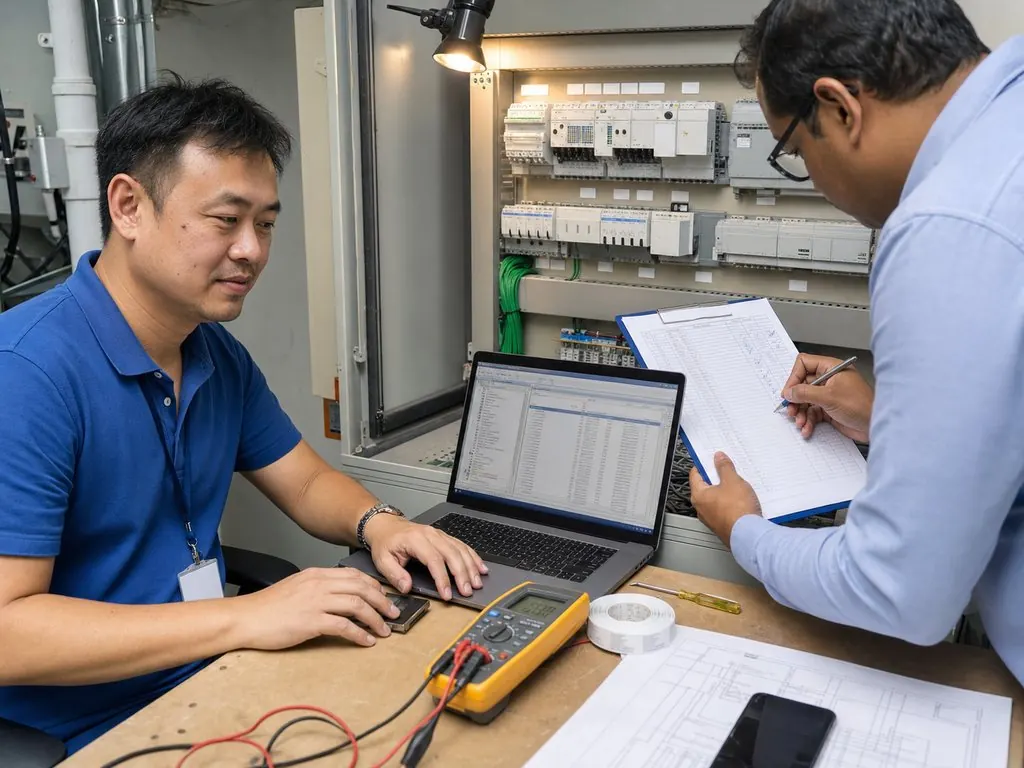

  • Witnessed testing, per circuit. Signed in front of someone. If it was not tested, it was not commissioned.
  • The handover pack and the training. As-built set, device inventory with warranty dates, operating guide, session with whoever runs the building.
  • Certified devices only. No uncertified hardware to hit a number, ever. It is the one shortcut that cannot be undone later.

What people say to us in this band

Usually within the first ten minutes, usually after somebody else has already told them KNX is not for them.

“KNX is for mansions. It is overkill for my house.”

KNX is a protocol, not a price bracket. A ten-device system speaks exactly the same standard as a ten-thousand-device airport, which is the entire point of an open standard. What makes a system expensive is device count and design hours, and both scale down cleanly. The 388 projects we have delivered under RM100,000 are the argument.

“Under RM100,000 you should just buy Wi-Fi smart switches.”

For a rental you are leaving in two years, honestly, sometimes yes. For a home you are wiring once, the comparison is not price against price - it is a closed cloud product with an average commercial life of about four years against an international standard with certified devices from 500 manufacturers and no dependency on any of them still existing. The cost of being wrong is a wall you already closed up.

“A small job means you will send a junior and rush it.”

The opposite, and for a selfish reason. Small systems in this band are our highest-volume work and every one of them is a support liability we carry for years. A rushed commissioning on a RM20,000 house costs us more in return visits than the margin on the job. The same engineer does the ETS work on every project we take, regardless of value.

“We will start cheap and upgrade properly later.”

That is a perfectly good plan, and it is the one we build for - as long as the first phase is engineered for the second. Topology, containment, spare ways and power headroom are laid for the building you might have. Then you fit what the budget covers now. What you must not do is buy a cheap closed system first, because that phase one has to be removed before phase two can start.

“Will you actually turn up for a job this size in two years?”

We hold the ETS project and back it up offsite, so a fault is a diagnosis and not an archaeology exercise, and maintenance contracts in this band start at RM2,880 a year. But the honest answer is stronger than a promise: because it is KNX and because you were handed the file, any certified integrator in Malaysia can take your system over without us. We would rather earn the work than lock you into it.

“Can you match a quotation I already have?”

We will not price-match blind, and we will tell you plainly if a cheaper quotation is a fair deal - it sometimes is. What we will do is read the other proposal against a like-for-like points list and show you exactly where the difference sits: device count, topology margin, programming scope, or documentation. Most of the time the gap is not margin. It is something that was left out and not mentioned.

Start with the number, not the wish list

Tell us the building and the ceiling you have. You get back a written scope that fits under it, a points list you can hand to any other integrator to price like for like, and an honest answer if the budget and the brief do not meet. That answer has been no often enough that we are comfortable giving it.

SITE SURVEY · FIXED WRITTEN SCOPE · NO VARIATION AFTER SIGN-OFF UNLESS YOU CHANGE IT

Who we work with

Five people ask us five completely different questions

A developer wants unit economics and a clean handover. An architect wants the plate to disappear into the wall. A consultant wants numbers to put a name against. An owner wants it to stop breaking. A resident just wants the room to behave. Pick yours.

Property developer working with KNX building automation on a Malaysian project

BULK RESIDENTIAL UNITS DELIVERED

1,400+

A smart-home story your sales gallery can actually deliver

Automation helps sell the unit. It then has to survive vacant possession, the defect liability period (DLP) and the handover to the joint management body (JMB). We build the package around all three, not just the show unit.

Repeatable per unit

One type-unit is engineered and signed off, then replicated with a per-unit ETS sub-project and serialised device schedule.

Follows your programme

Released block by block and floor by floor, so commissioning is never the item holding up vacant possession.

A defect period without arguments

Every unit hands over with a signed test sheet and a photographic panel record, so the cause of any defect is traceable rather than disputed.

Clean JMB handover

As-built set, ETS backup, device inventory with warranty dates, operating guide and a training session for the building team.

WHAT YOU RECEIVE FROM US

  • Per-unit bill of quantities and cost per unit at design stage
  • Show-unit and sales-gallery scene programming
  • Rollout schedule aligned to your vacant-possession dates
  • Per-unit test sheets and handover certificates
  • JMB documentation pack and training
  • Optional maintenance contract after handover
The sales gallery scene, running the way it will on handover

The sales gallery scene, running the way it will on handover

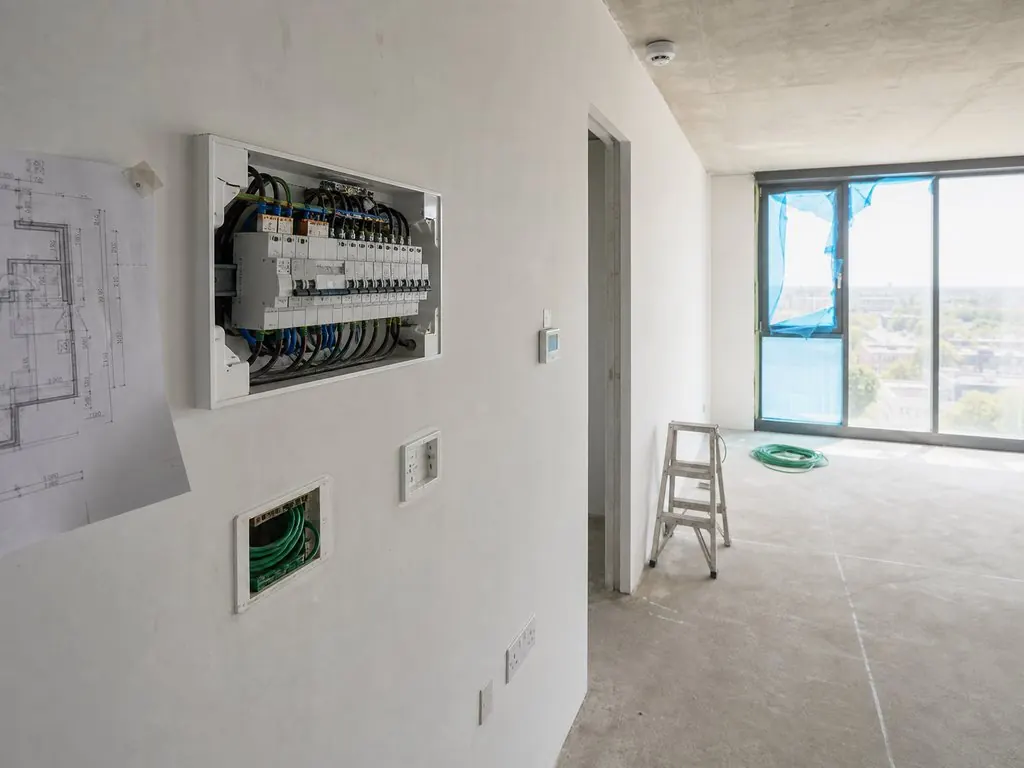

One type unit, engineered once and replicated per unit

One type unit, engineered once and replicated per unit

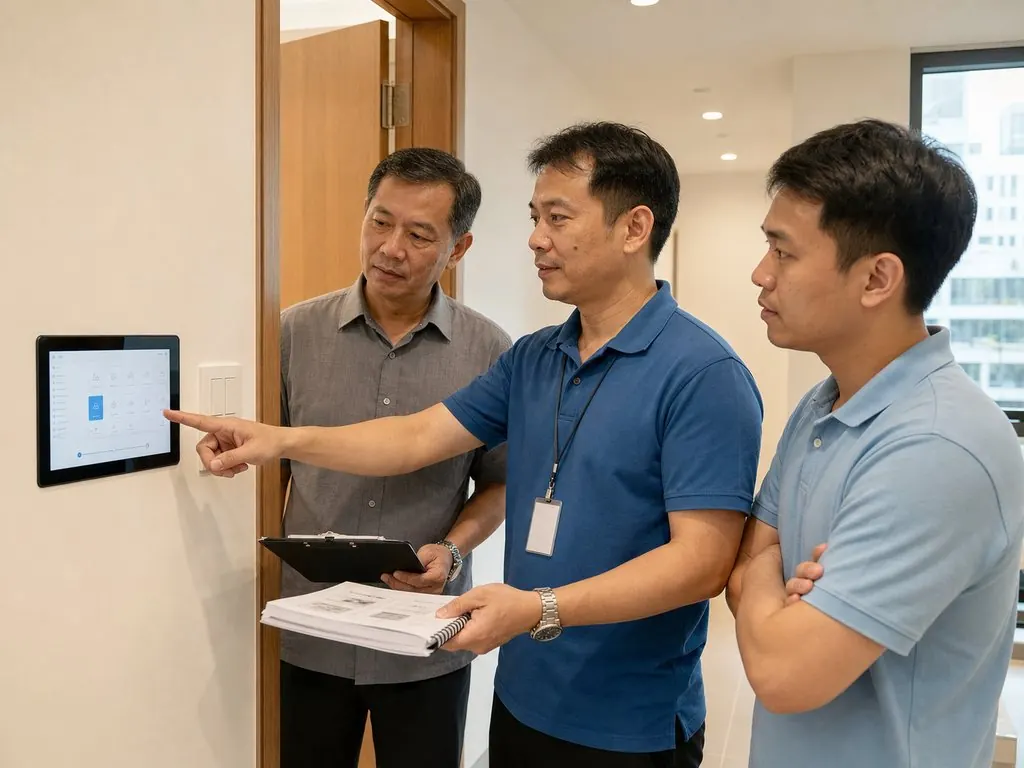

The building team trained on the system they inherit

The building team trained on the system they inherit

Architect working with KNX building automation on a Malaysian project

WALL CONTROL POINTS SPECIFIED

19,000+

Control that disappears into the detail you drew

Plate finish, back-box depth, sensor position on the reflected ceiling plan, how many buttons a wall carries. These are architectural decisions, and every one of them is cheaper to make at design stage than on site.

Finish, not clutter

Glass, brushed aluminium, matte black, timber veneer and custom-engraved plates across 500+ KNX brands, so the plate follows the material palette.

Fewer plates per wall

One KNX plate replaces a bank of switches. We reduce the wall furniture instead of adding to it.

Drawing-ready coordination

Symbol block, plate schedule and per-room control narrative issued in a form you can drop into your set.

Lighting design honoured

Scenes tuned on site against your intent: cove levels, tunable white, façade grazing, gallery lux limits.

WHAT YOU RECEIVE FROM US

  • Switch-plate schedule with finish and engraving
  • Back-box, depth and wall build-up requirements
  • Sensor positions marked for your reflected ceiling plan
  • Per-room control narrative in plain language
  • Scene commissioning walk-through with you on site
  • Sample plates for client presentation

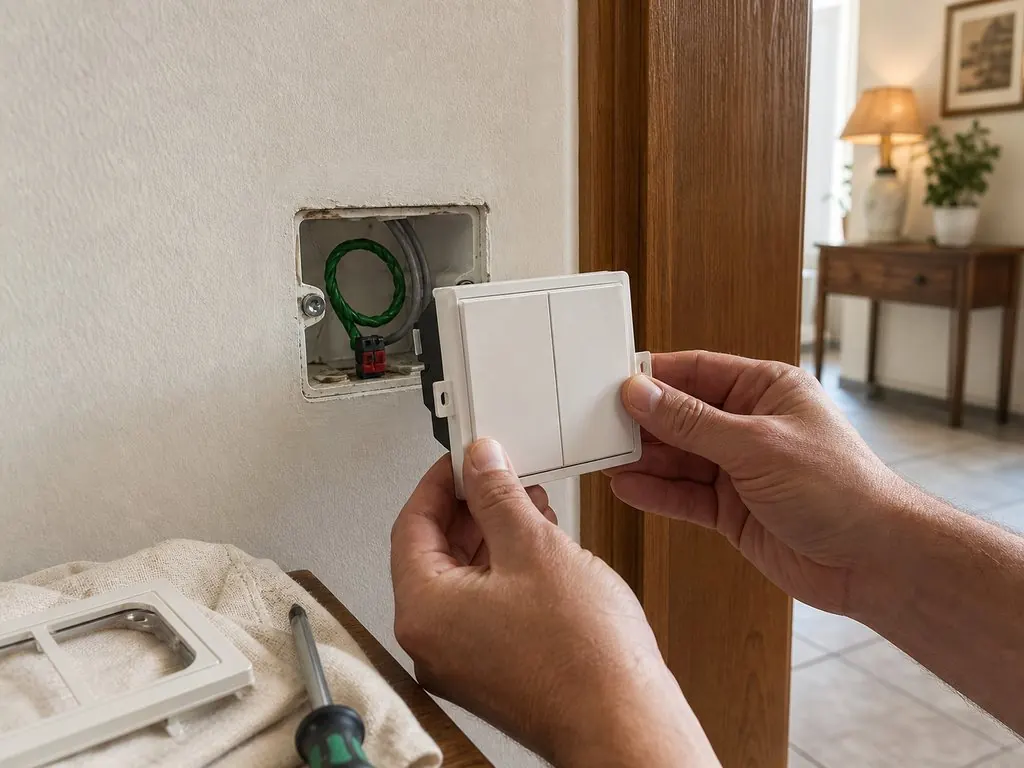

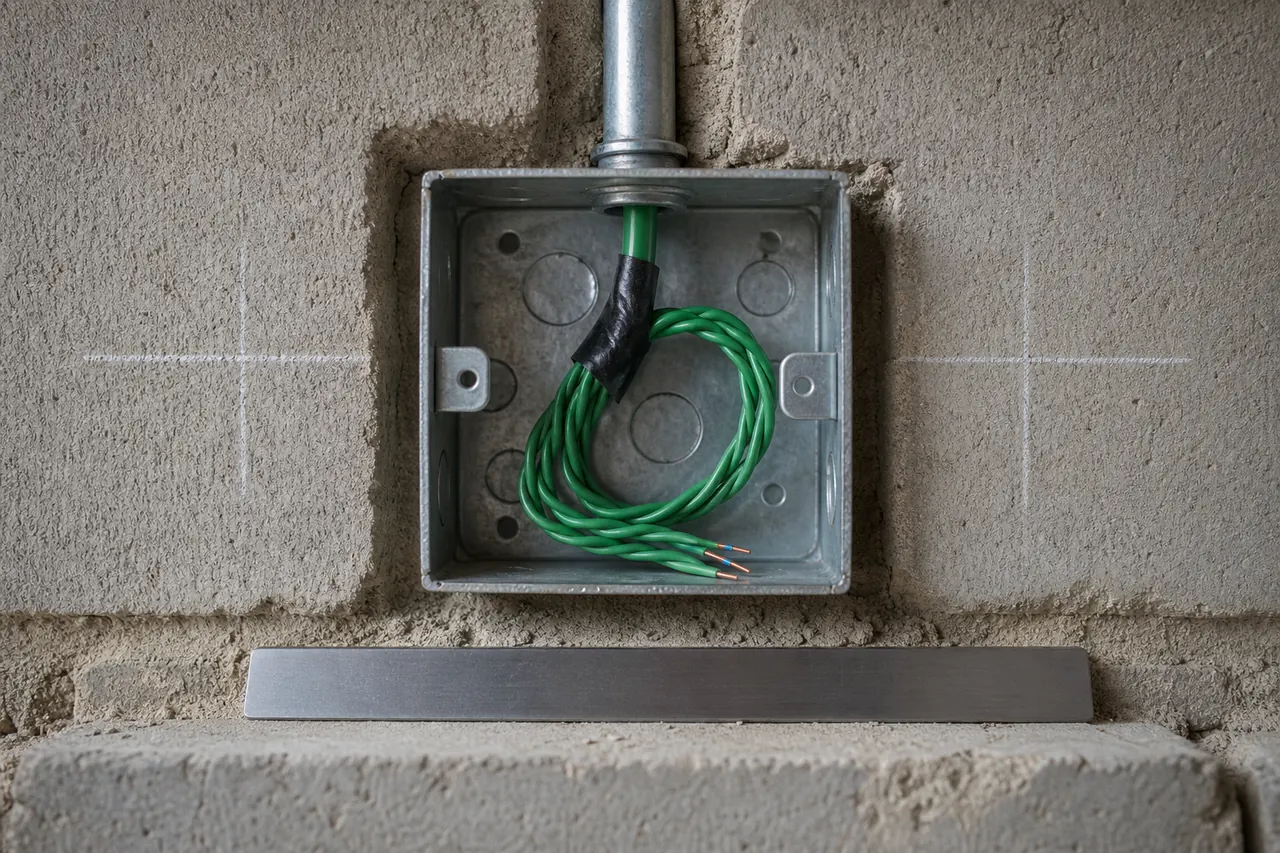

Back-box depth and position fixed before the wall is plastered

Back-box depth and position fixed before the wall is plastered

Detectors set on the ceiling grid, not wherever the installer reached

Detectors set on the ceiling grid, not wherever the installer reached

Plate families sampled against the material palette

Plate families sampled against the material palette

M&E consultant working with KNX building automation on a Malaysian project

BUS LINES DESIGNED AND COMMISSIONED

2,600+

A submission-ready package, not a brochure

You need topology, loading, sizing, points and a method statement you can put your name on. That is the first thing we produce, before anyone talks about hardware.

Topology and loading

Line and area segmentation, device count per line, bus-loading calculation and power-supply sizing with margin stated.

Interfaces defined

Points list for BACnet/IP, Modbus TCP/RTU and DALI-2, with object types and directions, agreed before procurement.

Vendor-neutral specification

A clause set at least three certified integrators can price like for like. No proprietary lock written into your tender.

Testing you can witness

Method statement, test sheets per circuit and per zone, and a witnessed functional test at handover. Not a verbal assurance that it works.

WHAT YOU RECEIVE FROM US

  • Bus topology and single-line diagrams
  • Bus-loading and power-supply sizing calculations
  • Riser, containment and cable schedule
  • Panel layouts and device schedules
  • Group-address structure and naming standard
  • Testing and commissioning method statement
Riser containment and segregation designed, not improvised

Riser containment and segregation designed, not improvised

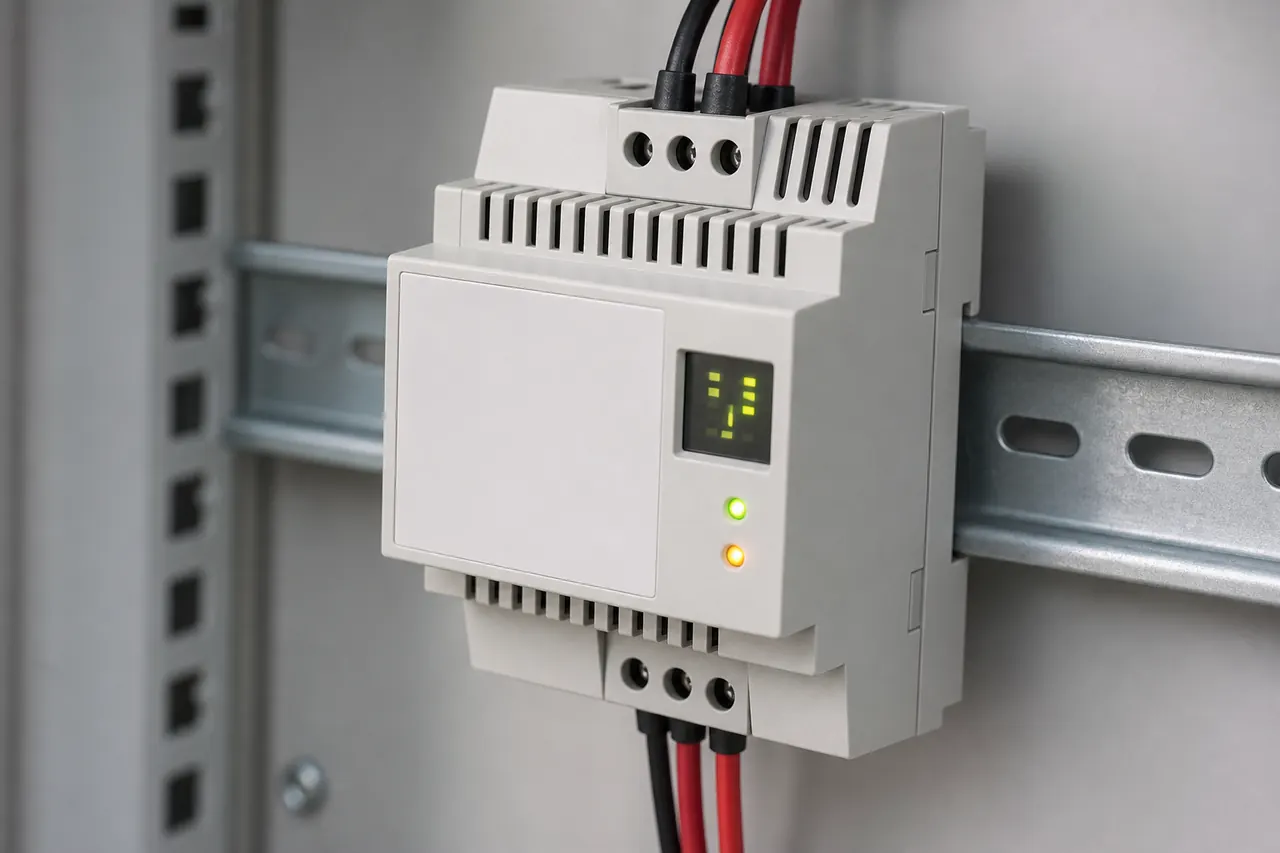

Power supplies sized with margin and reserved rail space

Power supplies sized with margin and reserved rail space

Witnessed testing against a written sheet, per circuit

Witnessed testing against a written sheet, per circuit

Resident / tenant working with KNX building automation on a Malaysian project

HOMES AND UNITS LIVING WITH OUR WORK

1,400+

You should never have to think about it

You are the one who actually lives or works in the building. The measure of a good system is not the app. It is that the room is already right when you walk into it, and that nothing ever needs explaining to a guest.

It still works like a switch

Every plate works by hand, exactly as a normal switch does. The app is a convenience, never the only way in.

Not dependent on the internet

Switches, sensors and schedules run on a local wired bus. If the router dies, your lights, air-conditioning and gate carry on.

A visibly smaller bill

Air-conditioning and lighting stop running in empty rooms. Most owners see the difference on the first or second bill.

Built around your household

Night paths for older parents, safe settings for children, prayer-time and festive scenes, and an away mode that makes the place look lived in.

WHAT YOU RECEIVE FROM US

  • A walk-through on the day of handover
  • A one-page guide anyone in the household can follow
  • Scenes tuned to how you actually use the rooms
  • Direct WhatsApp access to the engineer, not a call centre
  • Changes and additions without replacing anything
  • A system the next owner or tenant can also be taught in ten minutes
The evening scene, set once and then forgotten

The evening scene, set once and then forgotten

A night path for older residents, at floor level

A night path for older residents, at floor level

Open-house lighting on a single button

Open-house lighting on a single button

Owner / operator working with KNX building automation on a Malaysian project

ORPHANED SYSTEMS RECOVERED

75+

The building you inherited, brought back under control

Most buildings we take over were installed by someone who is no longer contactable. Open standard means you are never stuck: the system can be read, documented and returned to you.

Orphaned systems recovered

We read the live bus, rebuild the ETS project and group addresses, and document what is actually installed.

Running cost made visible

Sub-metered energy per floor, tenant and system, with reports your management can act on.

Contracted response

Preventive visits, bus health checks, offsite backups and an agreed response time instead of an emergency search.

Phased replacement

End-of-life devices swapped block by block against budget, never a rip-and-replace year.

WHAT YOU RECEIVE FROM US

  • Bus health and system condition audit
  • Recovered and re-documented ETS project
  • Energy baseline and monthly reporting
  • Maintenance contract with response SLA
  • Phased capital replacement plan
  • Operator training for your building team
What an orphaned system usually looks like when we arrive

What an orphaned system usually looks like when we arrive

The same panel rebuilt, labelled and documented

The same panel rebuilt, labelled and documented

Preventive visits on a schedule instead of emergencies

Preventive visits on a schedule instead of emergencies

55 project types. Not 55 variations of a smart home.

Breadth is what separates a KNX integrator from a smart-home dealer. A guardhouse boom barrier, a maximum-demand shedding sequence, a museum lux limit and a prayer-time lighting schedule are all the same bus and completely different engineering. Here is what has actually been delivered, by type.

Condominium show unit & sales gallery

Demonstration scenes, guided sequences and a reset routine that survives a thousand walk-throughs.

22DELIVERED

Serviced apartment bulk fit-out

Repeated type-unit template rolled out per unit with serialised device schedules.

14DELIVERED

Condo common area & clubhouse

Lobby, corridor, gym, pool deck and function room on scheduled and occupancy-driven scenes.

12DELIVERED

Link & terrace house

Whole-home lighting, air-conditioning scheduling, gate and alarm integration.

64DELIVERED

Semi-D & bungalow

Multi-zone lighting, shading, climate and security across three or more levels.

38DELIVERED

Penthouse & duplex

Cinema, multi-room audio, full shading and climate integration on a single bus.

9DELIVERED

Gated township landed rollout

Identical package deployed across a phase, with a common documentation standard.

6DELIVERED

SOHO & small office suite

Work and after-hours modes, presence-driven lighting, remote access.

13DELIVERED

Multi-generation & accessible home

Large tactile plates, night paths, fall-safe lighting and simple carer overrides.

8DELIVERED

Off-grid villa with solar & battery

Load priority and shedding logic tied to state of charge and generation.

4DELIVERED

Corporate HQ office floor (landlord CAT-A)

Base-build lighting zoning, daylight harvesting and metering ready for tenant split.

11DELIVERED

Tenant fit-out (CAT-B)

Tenant scenes and control tied back into the landlord base-build system.

17DELIVERED

Bank branch & front office

Trading-hours scenes, secure-area logic and after-hours lockdown.

5DELIVERED

Co-working & flexible workspace

Bookable-room logic, occupancy release and per-zone energy allocation.

10DELIVERED

Design studio & boutique office

Tunable white for colour-critical work, presence control, energy dashboard.

3DELIVERED

Data-centre support & ancillary areas

Corridor, plant-room and office-area control with environmental monitoring.

2DELIVERED

Boardroom & meeting-room logic

Presentation, video-call and cleaning scenes with AV and blind integration.

20DELIVERED

Boutique hotel guest-room management

Welcome, sleep and vacant modes with energy set-back on unoccupied rooms.

5DELIVERED

Phased hotel refurbishment

Floor-by-floor rollout while the hotel stays trading.

3DELIVERED

Resort villa cluster

Standalone villa control reporting into a central operations view.

3DELIVERED

Serviced residence guest control

Simple guest interface over a managed back-end with housekeeping status.

4DELIVERED

Restaurant & bar ambience

Day, dinner and late scenes with signage and exhaust scheduling.

12DELIVERED

Heritage shophouse café

Heritage-sensitive routing and surface finishes, full ambience control.

9DELIVERED

Production hall high-bay zoning

Aisle-by-aisle zoning with occupancy release on idle lines.

7DELIVERED

Warehouse daylight harvesting

Roof-light-linked dimming across bays, with maintained-lux control.

6DELIVERED

Cold room & process monitoring

Temperature logging, door-open alerts and out-of-band escalation.

3DELIVERED

Cleanroom support areas

Gowning, corridor and plant-area control outside the classified envelope.

2DELIVERED

Maximum-demand & load shedding

Staggered plant start-up and priority shedding to flatten the monthly peak.

8DELIVERED

Genset, ATS & incomer monitoring

Status, run-hours and changeover events surfaced to the operations view.

4DELIVERED

Solar PV & battery-aware control

Loads scheduled against generation and state of charge.

5DELIVERED

EV charging load management

Charger allocation capped against the building incomer.

4DELIVERED

University lecture theatre & lab

Presentation, exam and cleaning scenes with blackout blind sequencing.

4DELIVERED

School & kindergarten

Simple teacher controls, bell-linked schedules, holiday shutdown.

3DELIVERED

Clinic & specialist suite

Consult, procedure and waiting-room scenes with after-hours security.

8DELIVERED

Surau & mosque

Prayer-time lighting and air-conditioning driven by local azan timings.

6DELIVERED

Temple & church hall

Service, festival and caretaker scenes on a single wall plate.

3DELIVERED

Community & JMB hall

Bookable-hall lighting, air-conditioning run-time limits and usage logging.

5DELIVERED

Sports hall & court lighting

Per-court switching with warm-up sequencing and booking-linked timers.

4DELIVERED

Museum & gallery lighting

Lux and exposure limits on sensitive works, curated scene changes.

2DELIVERED

Mall common area & atrium

Trading-hours scenes, feature-lighting sequences and back-of-house control.

4DELIVERED

Retail lot & boutique

Open, trade, closing and stocktake scenes with façade signage timing.

15DELIVERED

Car & luxury showroom

Vehicle spotlight scenes, tunable white and after-hours display mode.

6DELIVERED

Supermarket & grocery

Aisle lighting zones with refrigeration and cold-aisle monitoring.

3DELIVERED

Guardhouse, barrier & perimeter

Boom barriers, perimeter beams, panic alerts and CCTV event triggers.

10DELIVERED

Landscape & façade lighting

Astronomical-clock scenes, festival modes and storm-safe operation.

14DELIVERED

Car park lighting & ventilation

Occupancy-linked dimming with CO-driven fan staging.

8DELIVERED

Swimming pool & water features

Pump, dosing and feature-lighting schedules with fault alerting.

7DELIVERED

Irrigation & roof garden

Zoned watering with rain skip and leak detection on the water meter.

6DELIVERED

Lift lobby & access scheduling

Floor-access rules by time and tenant, with full event logging.

8DELIVERED

Orphaned system recovery

Bus read back, ETS project and group addresses rebuilt, system re-documented.

24DELIVERED

Legacy BMS to KNX migration

Proprietary controls replaced or bridged, ending single-vendor lock-in.

8DELIVERED

DALI & DALI-2 lighting upgrade

Addressable luminaires brought under KNX with per-fitting fault reporting.

10DELIVERED

Phased device replacement

End-of-life hardware swapped block by block against an agreed budget.

11DELIVERED

Post-handover defect rectification

Developer-side snagging closed out with a traceable record per unit.

13DELIVERED

Pre-purchase system audit

Condition, documentation and residual-life report before an asset changes hands.

9DELIVERED

Not on the list? It has most likely been done once or twice and has not yet earned a row of its own. Describe the building and the constraint, and we will tell you honestly whether KNX is the right answer, or whether something simpler would serve you better.

What lands on your desk

The paperwork is the product

Hardware is a commodity: the same devices are available to everyone. What you are actually buying is the design that sizes them, the discipline that installs them and the documentation that lets someone else maintain them in year seven.

Design stage deliverables for a KNX building automation project

Design stage

  • Vendor-neutral specification clause set
  • Bus topology & single-line diagrams
  • Bus-loading & power-supply sizing calculations
  • Riser, containment & cable schedule
  • Switch-plate schedule with finishes
  • Sensor positions for the reflected ceiling plan
  • Indicative points list & bill of quantities
Build stage deliverables for a KNX building automation project

Build stage

  • Panel layouts & device schedules
  • Labelled DIN-rail build with combed cabling
  • Group-address structure & naming standard
  • Per-circuit installation test sheets
  • Site progress record with panel photography
  • Coordination notes for the electrical contractor
Handover deliverables for a KNX building automation project

Handover

  • Full as-built drawing set
  • ETS project file & offsite backup
  • Device inventory with warranty dates
  • Witnessed functional test certificate
  • Operating guide & quick-reference card
  • Operator and facility-team training session

Written against the standards you have to answer to

You are the one whose name goes on the submission. Everything we issue is framed so it can be attached to it without rewriting.

Request the spec clause set

Vendor-neutral and free. Written so three integrators can price it like for like.

ISO/IEC 14543-3

The KNX open standard itself. Guarantees any certified integrator can take the system over.

EN 50090

European home and building electronic systems series that KNX device certification is built on.

MS 1525

Malaysian energy-efficiency standard for non-residential buildings. Zoning, daylight and occupancy control and metering all map directly to KNX functions.

MS IEC 60364 / UBBL

Electrical installation and by-law requirements the containment, segregation and panel build are executed to.

GBI / GreenRE / LEED

Green-building rating tools where KNX control and metered data support energy-management credits.

EMEER 2008 (Energy Commission)

Sub-metered consumption data in the form a registered Electrical Energy Manager reports on.

Standards and programme references are given for general guidance. Applicability to a specific project should be confirmed with the relevant Malaysian authority or your appointed professional.

Right-sized engineering, not value-engineered to death

KNX earned its reputation on airports and five-star hotels, and a lot of integrators still price like it. We built the practice around the opposite problem: hitting a Malaysian budget without quietly deleting the parts that make the system last twenty years.

Where the cost actually comes out

  • Right-sized device count. Function per room is agreed before the bill of quantities, so nobody pays for channels that were never going to be used.
  • Multi-vendor sourcing. 500+ certified manufacturers interoperate. We mix them on price and lead time instead of honouring one distributor agreement.
  • Repeatable templates. On bulk residential, one type-unit is engineered once and replicated. Programming cost per unit falls sharply after the first.
  • Phased rollout. Infrastructure and containment first, intelligence later. KNX extends without rework if the topology was designed for it.
  • Energy pays part of the bill. A verified 20% to 35% reduction is real money against an operating budget, not a brochure number.

Where it never comes out

  • Topology margin. Lines are loaded with spare capacity and segmented properly. Cramming devices onto one line to save a coupler is how buildings get intermittent faults nobody can find.
  • Power-supply headroom. Sized with stated margin, never at the limit, and never shared across a segment it was not calculated for.
  • Labelling and containment. Both ends of every cable, every device, segregated from mains. This is what makes a fault a ten-minute job.
  • Documentation and backups. As-built set, group-address list, ETS project held and backed up offsite. A cheap system with no file is worth nothing the day it misbehaves.
  • Witnessed testing. Per circuit, per zone, signed. If it was not tested in front of someone, it was not commissioned.

“I have opened a lot of panels that were cheap on day one. Every one of them cost the owner more by year three. Cut the scope if you must, never the engineering.”

Peter Teh, lead KNX integrator
Peter Teh
TEH HON KEE · LEAD INTEGRATOR

TYPICAL ENGAGEMENT BANDS

From RM15,000

Single unit, entry scope, full standard

RM30,000 to RM100,000

Landed homes, floors, fit-outs, common areas

Above RM100,000

Towers, estates, bulk rollouts, phased plant

Indicative only. Every scope is surveyed and quoted in writing before anything is ordered.

388 of our projects sit under RM100,000

Four ways a project starts with us

Some clients arrive with a drawing set, some with a panel nobody dares open. Figures below are indicative starting points. Every building is surveyed and quoted in writing before anything is committed.

Maintenance contracts for KNX systems in Malaysia
CONTRACT

Maintenance contracts

Scheduled preventive servicing, bus health checks, ETS backups and a response time you can hold us to.

  • Quarterly or half-yearly visits
  • Guaranteed response time
  • ETS project and config backups

From

RM 2,880 /year

Request a plan
Repair and fault-finding for KNX systems in Malaysia
MOST URGENT

Repair and fault-finding

Bus-level diagnostics, telegram tracing and device testing to find the actual root cause, not the obvious symptom.

  • On-site and remote diagnostics
  • Bus monitor and telegram analysis
  • Emergency call-outs

Diagnostic from

RM 380 /visit

Book a call-out
New implementation for KNX systems in Malaysia
PROJECT

New implementation

Design-build from first principles: topology, loading, panel design, ETS programming, commissioning and documentation.

  • Design, BQ and schematics
  • ETS programming and commissioning
  • As-built docs and training

Project from

RM 14,800

Book a design review
Retrofit and system rescue for KNX systems in Malaysia
UPGRADE

Retrofit and system rescue

Take over an orphaned system, recover the ETS project, and add intelligence to an occupied building without wall hacking.

  • ETS recovery and re-documentation
  • Legacy or BMS migration to KNX
  • Phased device replacement

Audit from

RM 1,800

Request an audit

One accountable engineer, one trained crew

Consultation and design

Site survey, load and device schedules, riser and distribution board design, schematics and a scope engineered to land on your target budget.

ETS programming

Device addressing, group-address structuring, logic functions, scene creation and visualisation using official KNX ETS software. Documented and backed up.

Installation and retrofit

Professional cabling, DB build-out, device mounting and commissioning - wired TP or wireless KNX RF for occupied buildings with no wall-hacking.

After-sales support

24/7 WhatsApp support, remote diagnostics and rapid system modifications. You always reach the engineer who knows your system.

Maintenance packages

Scheduled preventive servicing, bus health checks, ETS project backups and priority SLA response - so small issues never become downtime.

Operator and user training

Hands-on training and plain-language documentation so the building team, or the household, runs the system day to day without calling anyone.

Repair and system rescue

Recover orphaned systems with no docs or passwords: re-read the bus, rebuild the ETS project, fix faults and bring the system back under control.

// QUICK SCOPE ESTIMATOR

An indicative budget in under a minute

Indicative only - we confirm on site. Want it component by component instead? Use the full budget calculator.

Small · 10Large · 600+

ESTIMATED RANGE

{{ estimateRange }}

{{ estimateUnit }}

Service{{ svcLabel }}
Property{{ buildingLabel }}
Scale~{{ est.devices }} devices

No obligation. We reply within business hours.

Keep it running: pick a service level

Cover that scales with the building. Every tier includes the ETS project backup and a written report you can put in front of ownership. Indicative pricing, confirmed after a site survey.

Essential

Bronze

Small buildings & homes

RM 2,880 /year

  • Response SLANext business day
  • Preventive visits1 / year
  • Remote monitoring -
  • ETS & config backupsYes
  • Emergency call-outChargeable
  • Annual health reportYes
Request this plan
RECOMMENDED

Professional

Silver

Mid-size & multi-tenant

RM 7,800 /year

  • Response SLAWithin 8 hours
  • Preventive visits2 / year
  • Remote monitoringBusiness hours
  • ETS & config backupsYes
  • Emergency call-outPriority
  • Annual health reportQuarterly
Request this plan

Enterprise

Gold

Towers, hotels, portfolios

From RM 14,800 /year

  • Response SLAUnder 4 hours
  • Preventive visits4 / year
  • Remote monitoring24/7 + alerts
  • ETS & config backupsYes + offsite
  • Emergency call-out24/7 included
  • Annual health reportMonthly + KPIs
Request this plan
Service van at the loading bay of a Kuala Lumpur office tower during an after-hours KNX call-out

Contract clients get a defined response time, not a queue position.

Gold tier covers 24/7 attendance. Every tier includes the offsite ETS backup.

See exactly what you will be handed

A working mock-up of the KNX supervision interface we deliver. Click the controls - they respond like the real dashboard your team uses daily.

Menara Demo · KNX Supervision

B1-L20 · {{ clock }}

BUS HEALTHY

ACTIVE LOADS

{{ activeLoads }}

POWER NOW

{{ powerNow }} kW

AVG TEMP

{{ avgTemp }}°C

OPEN FAULTS

{{ openFaults }}

FLOORS - TAP TO TOGGLE OCCUPANCY

{{ z.name }}

GA {{ z.ga }}

{{ z.on?z.level+'%':'off' }}

{{ h.zone }}

{{ h.mode }}

{{ h.set.toFixed(1) }}°

now {{ h.cur.toFixed(1) }}°C

TODAY · CONSUMPTION

{{ energyTotal }} kWh

VS YESTERDAY

−8.4%

HVAC

58%

LIGHTING

27%

OTHER

15%

{{ a.msg }}

{{ a.loc }} · {{ a.time }}

ACK'D

// With a maintenance contract, faults route to us automatically.

TIME SCHEDULES - TAP TO ENABLE

{{ s.name }}

{{ s.time }} · {{ s.days }}

From building data to management decisions

KNX does not only switch things on and off - it generates operational data. Our visualisation & energy servers turn that data into dashboards, reports and insights your management can act on. Try the interactive analytics console below.

Building Intelligence Console

Portfolio analytics · demo data

ENERGY COST

RM {{ kpi.cost.toLocaleString() }}

{{ kpi.costDelta }}% vs prev

ENERGY SAVED

{{ kpi.saved }}%

vs pre-KNX baseline

SYSTEM UPTIME

{{ kpi.uptime }}%

bus availability

WORK ORDERS

{{ kpi.wo }}

{{ kpi.woOpen }} open

AVG OCCUPANCY

{{ kpi.occ }}%

across floors

Energy {{ metric==='cost'?'cost (RM)':'consumption (kWh)' }} - {{ range }}

{{ l }}

Consumption by system

  • HVAC {{ split.hvac }}%
  • Lighting {{ split.light }}%
  • Other {{ split.other }}%

AUTO-INSIGHT

{{ insight }}

Maintenance work orders

exportable · CSV / PDF
{{ w.id }} {{ w.task }} {{ w.status }}

// Reports support operations, tenant cost allocation, energy compliance and capital-replacement decisions.

Operational reporting

Automated daily/monthly reports - energy, faults, run-hours and tenant sub-metering - emailed or exported to CSV/PDF.

Decision insights

Trend and anomaly detection flags drifting equipment and waste before it shows up on the bill or as a breakdown.

Big-data ready

Historical logging and open APIs (BACnet/Modbus/IP/REST) feed your BI tools, dashboards and ESG/energy compliance reporting.

Tablet showing a KNX energy and occupancy dashboard during a building operations review

Reports that survive a management meeting.

Energy, faults, run hours and tenant sub-metering, exported to CSV or PDF on a schedule.

See your payback before you commit

A control system only earns its place if it pays back. Move the sliders for an indicative saving and payback period, then let us confirm it with a metered baseline rather than an assumption.

RM12kRM250k+

Assumed energy reduction for a {{ buildingLabelRoi }}: {{ Math.round(roiPct*100) }}% of the bill.

MONTHLY SAVING

RM {{ roiMonthly.toLocaleString() }}

ANNUAL SAVING

RM {{ roiAnnual.toLocaleString() }}

PAYBACK PERIOD

{{ roiPayback }} yrs

10-YEAR NET

RM {{ roiTenYear.toLocaleString() }}

// Estimates use typical KNX savings ranges (20-35%). Actual results depend on the building and are confirmed on site.

Chiller plant room with insulated chilled-water headers and a wall-mounted control panel

Payback lives in the plant room, not the app.

Chillers, AHUs, high-bay lighting and car park loads are where a Malaysian building actually spends its money.

// KNX COMMAND HUD · NEXT-GEN INTERFACE

Run the building like a command deck

A concept operator interface built on the same live KNX data as the panel above: system gauges, a floor stack, the bus telegram stream and a command bar. Every control here is interactive, and we can build a supervision front end in this style or in a plain light theme.

KNX·OS CORE

menara-demo // bus online // {{ clock }}

LIVE DEVICES 248 UPLINK SECURE

// SYSTEM REACTORS

{{ Math.round(hud.busLoad) }}

BUS%

{{ Math.round(hud.power) }}

kW

{{ Math.round(hud.comfort) }}

COMFORT

CO₂612 ppm RH58% TEMP{{ avgTemp }}°C

// HOLO-STACK · TAP A FLOOR

{{ f.n }} {{ f.s }}

selected → {{ hud.floor }} · {{ hud.reply.length>0?'cmd ready':'' }}

// BUS TELEGRAM STREAM

{{ l.t }} ▸ {{ l.msg }}
capturing…

// ENERGY POWER CORE

{{ Math.round(hud.power) }}

kW NOW

{{ src.n }}{{ src.v }}

// real-time load distribution across sources & major loads

// ZONE RADAR · OCCUPANCY

ZONES LIVE28OCCUPIED17

ASSISTANT

{{ hud.reply }}

// Illustrative concept UI. We can deliver dashboards in this style or a clean light theme - your call.

What the bus actually controls

Nine functional domains, one twisted pair, one documented project file. Any of these can be added later if the topology was designed for it at the start.

KNX Lighting control in a Malaysian building

Lighting control

Complete lighting management - switching, dimming, tunable white and scene programming across every floor, lobby and common area. Works with LED, fluorescent, DALI and halogen.

  • On/off switching for all light circuits
  • Dimming 0-100% with soft start
  • Tunable white (warm↔cool) for circadian comfort
  • Scene recall - up to 64 scenes per area
  • Astronomical clock (auto-adjust to sunset)
  • Constant-light & daylight harvesting for offices
Typical saving: 40-60% of lighting energy
KNX Climate and HVAC control in a Malaysian building

Climate and HVAC control

Intelligent HVAC tuned for Malaysia’s hot, humid climate. Per-zone setpoints, scheduling and presence logic across split units, FCUs and central VRV/VRF plant.

  • Split AC control (Daikin, Mitsubishi, Panasonic)
  • VRV/VRF central system integration
  • Fan-coil unit (FCU) control for high-rise
  • Temperature & humidity monitoring + logging
  • Presence-based auto on/off (empty-room detection)
  • Window/door-open detection (auto AC cut-off)
  • Pre-cooling schedules for hot afternoons
Typical saving: 30-45% of AC energy - the biggest TNB bill item
KNX Motorised shading and blinds in a Malaysian building

Motorised shading and blinds

Automated curtains, roller blinds and external awnings with weather protection - essential for west-facing façades and the monsoon season.

  • Motorised curtain tracks (ceiling/wall)
  • Roller blinds - sun or blackout fabric
  • External awnings with wind/rain sensors
  • Sun-tracking by light intensity
  • Auto-close during downpours
  • Wind-speed safety retract
Scenes: “Good Morning”, “Movie Time”, “Away” simulation
KNX Security system integration in a Malaysian building

Security system integration

Unify existing alarms, CCTV, auto-gate and access control on one bus - popular for gated developments and managed buildings.

  • Alarm integration (DSC, Paradox, Honeywell)
  • Motion-detector zones (PIR)
  • Door/window magnetic contacts
  • CCTV trigger recording on event
  • Auto-gate remote open/close
  • Presence simulation when vacant
  • Panic button → instant guardhouse alert
Safety: auto emergency lighting + WhatsApp alert on alarm
KNX Energy monitoring and management in a Malaysian building

Energy monitoring and management

Real-time consumption tracking, sub-metering and intelligent load management - see exactly which systems and floors burn the most power, and prove the savings to ownership.

  • Real-time kWh tracking per circuit/floor
  • Sub-metering & cost allocation by tenant
  • Peak-demand limiting / load shedding
  • Solar-PV & battery awareness
  • Historical logging & exportable reports
  • Anomaly alerts (consumption out of band)
Turns the electricity bill into a managed, reportable line item
KNX Access control and doors in a Malaysian building

Access control and doors

Door, turnstile and lift-lobby control with scheduled access and full event logging - ideal for managed and tenanted buildings.

  • Scheduled door/turnstile access
  • Lift-lobby & floor access logic
  • Smart-lock & keypad integration
  • Visitor & after-hours rules
  • Event logging for audit trails
  • Lockdown & emergency-egress scenes
Every access event timestamped and reportable
KNX Audio and public address in a Malaysian building

Audio and public address

Multi-zone audio, background music and PA/evacuation messaging integrated into the same system - for hospitality, lobbies and common areas.

  • Multi-zone background music
  • Source & volume control per zone
  • PA / evacuation message integration
  • Scene-linked audio (e.g. “Open House”)
  • Door-bell & intercom routing
  • App & wall-panel control
One interface for comfort audio and life-safety PA
KNX Landscape and irrigation in a Malaysian building

Landscape and irrigation

Automated irrigation, water metering and landscape/façade lighting for grounds, podiums and roof gardens.

  • Zoned irrigation scheduling
  • Rain & soil-moisture skip logic
  • Water-meter monitoring & leak alerts
  • Landscape & façade lighting scenes
  • Water-feature & fountain control
  • Seasonal programmes
Cuts water waste and protects the landscaping budget
KNX Voice and third-party integration in a Malaysian building

Voice and third-party integration

Optional voice control plus certified gateways to BACnet, Modbus, DALI and IP - so KNX talks to your existing BMS rather than replacing it.

  • Voice (Google, Alexa, Siri/HomeKit)
  • BACnet/IP & Modbus TCP/RTU gateways
  • DALI lighting gateways
  • IP/cloud dashboards & remote access
  • REST/API hooks for custom systems
  • Works alongside an existing supervisory BMS
Integrate, do not rip out and replace

Works with the systems you already have

KNX is the neutral layer that ties your building together. We bridge to other protocols and equipment through certified gateways - so you extend what you own instead of ripping it out.

Open protocols

  • KNX/IP, KNX RF, KNX TP
  • BACnet/IP gateway
  • Modbus TCP & RTU
  • DALI / DALI-2 lighting

HVAC & plant

  • Daikin, Mitsubishi, Panasonic
  • VRV/VRF central systems
  • Chillers & AHUs via Modbus
  • FCU valve actuators

Security & access

  • Hikvision / Dahua CCTV
  • DSC / Paradox / Honeywell alarms
  • Auto-gates & barriers
  • Smart locks & turnstiles

AV & comfort

  • Sonos & multi-zone audio
  • PA / evacuation systems
  • IR for TVs & AV
  • Video intercom / doorbell

Apps & voice

  • Apple HomeKit / Siri
  • Google Assistant
  • Amazon Alexa
  • iOS & Android apps

Data & cloud

  • REST / IP APIs
  • Energy & BI dashboards
  • Email / CSV / PDF reports
  • Existing supervisory BMS
Roof plant deck with VRF condenser units and neatly run refrigerant pipework on a Malaysian commercial building

Your plant keeps its own controls. KNX just gets to talk to it.

Certified gateways to BACnet/IP, Modbus TCP and RTU, DALI-2 and every major VRF manufacturer.

How a project runs, stage by stage

On a bulk rollout the same sequence repeats per block, so commissioning tracks your programme instead of piling up at the end.

Cabling and containment, KNX Malaysia project work
STAGE 01
Cabling and containment

Bus cable, containment and distribution boards installed to schedule, segregated from mains and labelled at both ends.

ETS engineering, KNX Malaysia project work
STAGE 02
ETS engineering

Device addressing, group-address structure, logic, scenes and visualisation, all held in a project file that stays yours.

Commissioning and handover, KNX Malaysia project work
STAGE 03
Commissioning and handover

Witnessed functional testing, on-site scene tuning, documentation issued and the building team trained on it.

Where the package sits in a developer programme

The expensive mistake is treating automation as a fit-out item. Containment, back boxes and riser space are structural decisions. Get them into the electrical package and the intelligence can be added at any point afterwards for a fraction of the cost.

Book a design review
01

Concept & schematic design

Control philosophy per space, indicative device count, budget band and a cost-per-unit figure the feasibility can carry.

02

Detailed design & tender

Vendor-neutral specification, topology and loading, riser and containment requirements, plate schedule, points list and bill of quantities.

03

Electrical package on site

Containment, back boxes, bus cable pulled and tested by the electrical contractor against our schedule. No automation devices yet.

04

Type-unit engineering

One unit built, programmed, tested and signed off as the template that every subsequent unit is replicated from.

05

Block-by-block rollout

Devices installed and programmed per unit against the vacant-possession sequence, each with its own test sheet.

06

Handover and defect liability period

As-built set, ETS backup, device inventory and training for the building team, then a traceable defect record for the whole liability period.

And the same discipline on a single building

01

Assess

Site survey, DBs & bus topology

02

Document

Read bus with ETS, rebuild docs

03

Design / Quote

Clear scope + fixed quotation

04

Install

Cabling, mounting, ETS - phased

05

Commission

Testing, tuning & handover

06

Maintain

SLA support & backups

Most faults we are called to fix were created at cabling stage

Cabling is the one layer you cannot revisit cheaply once the walls close. Segmentation, power-supply placement, labelling and containment decide whether the building is serviceable for the next twenty years.

Structured KNX cabling topology for a multi-storey building: a backbone riser feeding a line coupler and dedicated bus power supply in each floor distribution board, with branch lines out to switches, sensors and actuators
Correctly built KNX panel with labelled devices and combed twisted-pair cabling

With structured cabling

  • Segmented lines & adequate power supplies
  • Neat, labelled DB panels
  • Easy fault isolation & expansion
  • Documented as-built & group addresses
  • Reliable for 20+ years
Poorly built control panel with tangled unlabelled cabling and a removed device

Without it

  • Overloaded lines & random dropouts
  • Messy, unlabelled panels
  • One fault takes down many devices
  • No documentation - a black box
  • Costly to repair or extend

The layer you only get one chance at

We design TP, KNX RF wireless and IP backbones correctly the first time - labelled, documented and handed over. Never a black box.

The standard, and why it protects you

KNX is the worldwide open standard for home and building control, published as ISO/IEC 14543-3. The open part is what matters commercially: no single manufacturer owns your building, and any certified integrator can pick the system up from the documentation.

KNX protocol architecture

Devices share one bus and talk via group addresses - watch a telegram travel the line.

Sensors

Buttons, PIR, temp, lux, weather - send telegrams

KNX Bus (TP/RF/IP)

Shared twisted-pair / wireless / IP backbone

Logic & Couplers

Scenes, schedules, segmentation & filtering

Actuators

Switch, dim, drive blinds & valves on command

// decentralised - no central PC required; every device is intelligent

KNX hardware ecosystem

Switch and dim real-world loads on the bus.

Switch actuators

2-24 channel, 16/20A - lighting & general loads

Dimming actuators

Universal / DALI / 1-10V dimming, 0-100%

Shutter/blind actuators

Up/down/stop with position feedback

Heating/valve actuators

0-10V & PWM for FCU valves

Energy actuators

Switching with integrated metering

Feed the bus with real conditions and presence.

Presence/motion (PIR)

Occupancy + constant-light control

Temperature & humidity

Per-zone comfort sensing

Light/lux sensors

Daylight harvesting

Weather stations

Wind, rain, sun for shading & façade

Air-quality (CO₂/VOC)

Demand-controlled ventilation

The brains: logic, scenes, schedules and visualisation.

Logic modules

Conditions, timers, scenes, sequences

Visualisation servers

Web/app dashboards & remote access

Time/astro schedulers

Calendar, sunrise/sunset logic

Energy managers

Load profiling & demand limiting

Line/area couplers

Topology segmentation & filtering

Bridges to IP and to other building systems.

KNX/IP interfaces & routers

ETS programming + IP backbone

BACnet gateways

Tie into a supervisory BMS

Modbus gateways

Meters, chillers, gensets

DALI gateways

Addressable lighting

AV/IR & 3rd-party gateways

Sonos, Daikin, HomeKit, etc.

Wall interfaces and control plates

Capacitive glass panel, KNX wall control interface

Capacitive glass panel

Backlit glass in warm white or black, custom engraving, status indication and an integrated room temperature readout.

Brushed metal rocker, KNX wall control interface

Brushed metal rocker

The familiar rocker feel with KNX intelligence behind it. Nobody has to be taught how to use a light switch.

Colour touch display, KNX wall control interface

Colour touch display

Full room or whole-building visualisation on the wall, for spaces where one plate has to do a lot of work.

Flush sensor plate, KNX wall control interface

Flush sensor plate

Temperature, humidity and presence in a plate that matches the switch family, so the wall stays quiet.

A home router unplugged while the corridor night lighting scene continues to run

Router unplugged. The night scene is still running.

Switches, sensors, schedules and logic all live on the local bus. Internet is only needed to reach the building from outside it.

Factor
KNX (wired open standard)
Consumer WiFi gadgets
Reliability
Wired bus - works without internet/cloud
Depends on WiFi & vendor cloud uptime
Lifespan
Designed for 20+ years as building infrastructure
Consumer churn, 2-4 years typical
Interoperability
Open standard - 500+ brands interoperate
Walled gardens, app fragmentation
Security
Local, no cloud dependency, AES-128 options
Cloud accounts, remote-breach surface
Scale
Whole-building, thousands of devices
Router/hub limits, congestion
Serviceability
Any certified engineer can take over
Often locked to one vendor/app

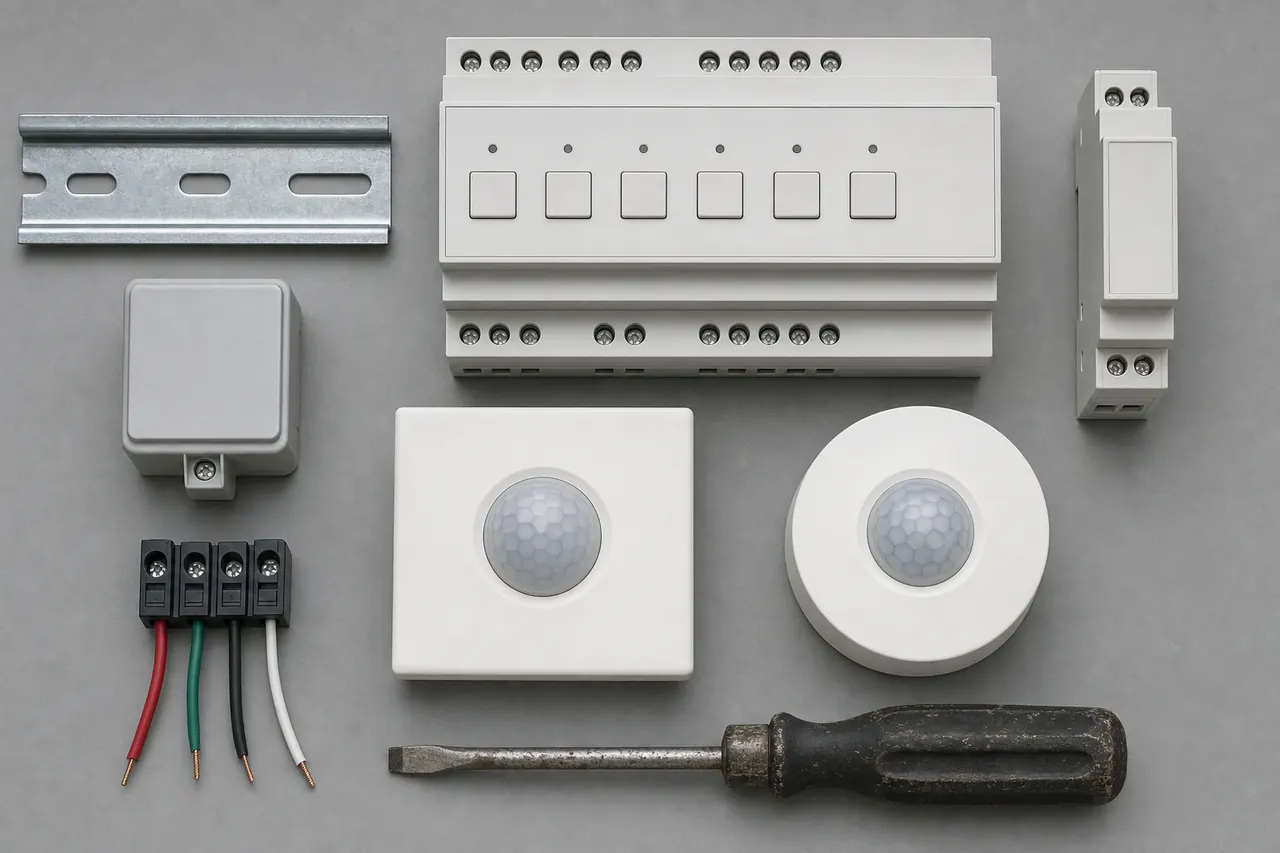

Overhead flat lay of KNX hardware: DIN-rail modules, power supply, presence detector, sensor plate and bus terminal

One protocol, hundreds of manufacturers, one project file.

Specified on merit and lead time. Nothing here is locked to a single supplier.

Eighteen entries from the project record

Client names stay confidential unless they have told us otherwise, so these are described the way a peer would want to read them: what the constraint was, what was engineered, and what was handed over.

Residential tower, Klang Valley, Developer bulk rollout, 2 blocks - KNX Malaysia project record

Residential tower, Klang Valley

Developer bulk rollout, 2 blocks

One type-unit engineered and signed off, then replicated per unit with its own ETS sub-project and serialised device schedule. Released floor by floor to follow the vacant-possession programme.

Units delivered
Bulk, phased
Common areas
Lobby, corridor, gym, deck
Handover
Per-unit test sheet + JMB pack
TYPE-UNIT TEMPLATEPHASED VPJMB PACK
Sales gallery and show unit, Developer launch package - KNX Malaysia project record

Sales gallery and show unit

Developer launch package

A guided demonstration sequence a sales consultant can run in ninety seconds, plus a reset routine that returns the unit to its opening state after every viewing. Programmed so a thousand walk-throughs cannot leave it in a broken scene.

Demo
One-touch guided sequence
Reset
Automatic between viewings
Handover
Same platform as the sold units
DEMO SEQUENCERESET ROUTINELAUNCH READY
Serviced apartment bulk fit-out, Type-unit template, replicated per unit - KNX Malaysia project record

Serviced apartment bulk fit-out

Type-unit template, replicated per unit

One unit is engineered, programmed, tested and signed off as the template. Every subsequent unit is a replication with its own ETS sub-project, serialised device schedule and test sheet, so programming cost per unit falls sharply after the first.

Engineered once
Signed-off type unit
Per unit
Own ETS sub-project
Cost curve
Falls after unit one
ONE TEMPLATESERIALISEDPER-UNIT FILE
Corporate office floors, KL, Landlord base-build plus tenant fit-out - KNX Malaysia project record

Corporate office floors, KL

Landlord base-build plus tenant fit-out

Base-build lighting zoned and metered so tenant consumption splits cleanly, then tenant scenes layered on top without touching the landlord logic. After-hours waste was the first thing the data exposed.

Control
Presence + constant lux
Metering
Per floor and per tenant
Reporting
Monthly, exportable
DALI-2DAYLIGHT HARVESTINGSUB-METERING
Boutique hotel, heritage district, Guest-room management, phased - KNX Malaysia project record

Boutique hotel, heritage district

Guest-room management, phased

Welcome, sleep and vacant modes per room with energy set-back on unoccupied stock. Rolled out one floor at a time so the hotel never stopped trading.

Rooms
Floor-by-floor release
Set-back
Automatic on vacancy
Front desk
Room status at a glance
GRMSVACANT SET-BACKTRADING THROUGHOUT
Manufacturing plant, southern corridor, High-bay zoning and demand control - KNX Malaysia project record

Manufacturing plant, southern corridor

High-bay zoning and demand control

Aisle-by-aisle high-bay zoning with occupancy release on idle lines, plus staggered plant start-up and priority shedding to flatten the monthly maximum-demand charge.

Lighting
Zoned per production aisle
Demand
Staggered start + shedding
Data
Modbus meters into KNX
HIGH-BAYLOAD SHEDDINGMAXIMUM DEMAND
Gated township, Selangor, Estate infrastructure and landed phase - KNX Malaysia project record

Gated township, Selangor

Estate infrastructure and landed phase

Guardhouse, boom barriers, perimeter beams and panic alerting tied into the same bus as landscape and streetscape lighting, with an identical home package repeated across the landed phase.

Perimeter
Barriers, beams, panic
Streetscape
Astro-clock scenes
Homes
One repeatable package
GUARDHOUSESTREETSCAPELANDED PHASE
Mall concourse and atrium, Common-area scenes and feature lighting - KNX Malaysia project record

Mall concourse and atrium

Common-area scenes and feature lighting

Trading-hours scenes across the concourse with a tunable-white gradient through the feature cove, plus back-of-house and service-corridor control on the same system.

Scenes
Open, trade, close, clean
Feature cove
Tunable white sequence
Override
Centre-management panel
ATRIUMTUNABLE WHITETRADING HOURS
University teaching block, Lecture theatres and laboratories - KNX Malaysia project record

University teaching block

Lecture theatres and laboratories

Presentation, exam and cleaning scenes with sequenced blackout blinds, driven from one plate at the lectern so teaching staff never need a manual.

Rooms
Theatres, labs, seminar
Control
One plate per room
Blinds
Sequenced with scene
PRESENTATION SCENESBLACKOUT BLINDSEXAM MODE
Heritage shophouse conversion, Boutique café, conservation constraints - KNX Malaysia project record

Heritage shophouse conversion

Boutique café, conservation constraints

Full ambience control delivered without cutting into original fabric: surface routing agreed with the conservation consultant, plates recessed only where the wall build-up already allowed it.

Fabric
No original material cut
Scenes
Day, dinner, late, close
Plates
Finish-matched to interior
CONSERVATIONSURFACE ROUTINGAMBIENCE
Orphaned system recovery, Managed office tower, no documentation - KNX Malaysia project record

Orphaned system recovery

Managed office tower, no documentation

Original integrator uncontactable, no ETS file, no passwords, nobody willing to touch the panel. We read the live bus, rebuilt the project and group addresses, re-labelled the panel and took over maintenance.

Found
No file, no labels
Rebuilt
Full ETS + group addresses
Now
Under contract, backed up
ETS RECOVERYRE-DOCUMENTEDTAKEN OVER
Control panel build standard, How every panel leaves our bench - KNX Malaysia project record

Control panel build standard

How every panel leaves our bench

Device labelling, combed twisted-pair runs, segregation from mains, spare capacity stated and the wiring diagram in the door pouch. This is the difference between a system you can service in ten minutes and one nobody dares open.

Labelling
Every device, both ends
Spare ways
Stated at handover
Diagram
Inside the panel door
LABELLEDCOMBEDDOCUMENTED
Commissioning and witnessed testing, What actually gets signed off - KNX Malaysia project record

Commissioning and witnessed testing

What actually gets signed off

Bus voltage and loading verified, telegram traffic monitored under load, every circuit and every zone tested against a written sheet, then a functional test witnessed by the consultant or owner before handover.

Verified
Voltage, loading, traffic
Recorded
Per circuit, per zone
Signed
By the witness, at handover
BUS MONITORTEST SHEETSWITNESSED
Basement car park, mixed-use development, Occupancy-linked lighting and CO ventilation - KNX Malaysia project record

Basement car park, mixed-use development

Occupancy-linked lighting and CO ventilation

Aisles dim to a safe standby level and lift to full on detection, while extract fans stage against CO rather than running flat out. One of the fastest paybacks in any building because the load runs all day.

Lighting
Standby plus occupancy lift
Ventilation
CO-staged fans
Reporting
Run hours per fan
OCCUPANCY DIMMINGCO STAGINGRUN HOURS
Facade and crown lighting, mixed-use tower, Architectural scene control - KNX Malaysia project record

Facade and crown lighting, mixed-use tower

Architectural scene control

Astronomical-clock switching with curfew dimming, festival colour scenes for Raya, Chinese New Year and Deepavali, and an automatic safe state when the weather station reports high wind or heavy rain.

Switching
Sunset to curfew, by date
Scenes
Festival and national days
Safety
Weather-triggered safe state
ASTRO CLOCKFESTIVAL SCENESSTORM SAFE
Surau, corporate campus, Prayer-time lighting and cooling - KNX Malaysia project record

Surau, corporate campus

Prayer-time lighting and cooling

Lighting and air-conditioning follow the daily prayer schedule instead of running all day, with a manual override for Friday and Ramadan. A small scope that quietly removes a large share of an idle building load.

Schedule
Follows local azan timings
Override
Manual, at the wall
Set-back
Automatic between prayers
AZAN TIMINGSZONED COOLINGLOW ENERGY
EV charging bays, commercial car park, Charger load capped to the incomer - KNX Malaysia project record

EV charging bays, commercial car park

Charger load capped to the incomer

Charger output is allocated dynamically against measured building load, so bays can be added without upgrading the incoming supply and without pushing the monthly maximum-demand charge.

Allocation
Dynamic, against live load
Supply
No incomer upgrade
Priority
Building loads first
LOAD ALLOCATIONMAX DEMANDNO UPGRADE
Wall interface finish study, Plate selection for an interior package - KNX Malaysia project record

Wall interface finish study

Plate selection for an interior package

Five plate families sampled against the material palette before a single back box was set out, so the plate schedule went into the tender drawings rather than being decided on site.

Sampled
Glass, alu, black, timber
Fixed early
Back-box depth agreed
Output
Plate schedule + symbols
GLASSALUMINIUMENGRAVED

Fixed-scope packages for a single home or unit

Published prices for the three scopes we are asked for most often. Each one is the full engineering standard at a smaller scale, and each one extends later without replacing what is already on the bus.

Condo Essential

Perfect for 3-bedroom condos & apartments

RM 14,888

indicative · incl. installation & programming

  • Lighting control + dimming
  • AC / FCU control
  • Mobile app control
  • 4 smart glass switches
  • ETS programming & handover
Enquire
MOST POPULAR

Terrace / Link House

Double-storey link & terrace homes

RM 24,888

indicative · incl. installation & programming

  • Whole-home lighting scenes
  • AC scheduling
  • Auto-gate & alarm integration
  • Motion sensors
  • Voice control ready
Enquire

Wireless Retrofit

Existing/occupied homes - no wall hacking

RM 18,888

indicative · incl. installation & programming

  • KNX RF wireless
  • Lighting + shading
  • No renovation needed
  • App + scenes
  • Expandable later
Enquire

Larger buildings & portfolios are scoped and quoted individually - request a site assessment.

Condominium living room in the evening with an automated lighting scene and a flush glass control plate

The entry package, running an evening scene.

Every pack is the full standard at a smaller scope.

Engineer fitting a flush control plate into an existing back box on a finished marble wall without hacking

The retrofit pack, going into a finished wall.

Wireless KNX RF where hacking the wall is not an option.

// KNX BUDGET CALCULATOR

Work out your own ballpark before you call anyone

Count what you can see in your own building: the plates on the wall, the buttons on them, the circuits, the air-conditioning zones. The calculator sizes the parts you cannot see, such as power supplies, line couplers and DALI gateways, because those fall out of the device count rather than out of a wish list. Installation, repair and maintenance are costed differently, so pick the one you actually need.

01 · LEVELS, ZONES AND REPEATS

A repeat unit is an identical layout done again, such as 40 condo units off one type-unit design. Hardware multiplies, the engineering is written once.

02 · SWITCHES AND PANELS

Count the plates on the wall, then the total number of buttons across all of them. A four-gang plate is four buttons.

03 · SENSORS

04 · ACTUATOR AND DIMMER CHANNELS

Count channels, not boxes. One channel drives one lighting circuit, one blind or one valve.

05 · LIGHTING PROTOCOL AND METERING

06 · GATEWAYS AND INTEGRATION

07 · GROUPING AND PROGRAMMING

Grouping, scenes and schedules are engineering hours in ETS, not parts on a shelf. They are priced as work.

08 · SITE CONDITIONS AND DELIVERY

09 · WHERE IS THE BUILDING

01 · THE FAULT

A repair is not priced off your device list. It is priced off how much of the bus we have to trace, and how much of it we have to replace.

02 · WHAT WE INHERIT

Without the project file the bus has to be scanned and re-documented before anything can be corrected safely. That recovery is the single biggest line in most rescue jobs.

03 · ATTENDANCE

WHERE IS THE BUILDING

01 · THE SYSTEM

A contract is priced on what has to be kept alive, not on what it cost to build. If you do not know the device count, the ETS project will tell us on the first visit.

02 · SERVICE LEVEL

WHERE IS THE BUILDING

INDICATIVE BUDGET

RM -

{{ calcRange }}

Add a few switches, sensors or circuits on the left and the figure appears here.

{{ calcUnit }}

Your scope prices below our RM15,000 minimum. Under that figure the fixed cost of surveying, programming, commissioning and documenting a system properly eats the whole budget, so the range is held at the minimum rather than quoted lower.

WHERE THE MONEY GOES

  • Switches, panels, sensors{{ labMoney(calcInstall.hwField) }}
  • Actuators, dimmers, meters{{ labMoney(calcInstall.hwPanel) }}
  • Gateways and DALI{{ labMoney(calcInstall.hwGate) }}
  • Power, couplers, boards, bus cable{{ labMoney(calcInstall.hwInfra) }}
  • Containment, glands, labels, consumables{{ labMoney(calcInstall.sundry) }}
  • Site labour, charged out{{ labMoney(calcInstall.site) }}
  • ETS engineering, commissioning, handover{{ labMoney(calcInstall.eng) }}

That labour is {{ labHrs(calcInstall.hours) }} of work. Break it down by trade in the labour estimator below.

SIZED FOR YOU, NOT ASKED OF YOU

A KNX line carries 64 devices. Power supplies, line couplers and DALI gateways follow from the count, so nobody should be asking a client to guess them.

BUS DEVICES

{{ calcScope.devices }}

TOTAL ACROSS UNITS

{{ calcScope.totalDevices }}

KNX LINES

{{ calcScope.lines }}

POWER SUPPLIES

{{ calcScope.psu }}

LINE COUPLERS

{{ calcScope.couplers }}

DALI GATEWAYS

{{ calcScope.daliGw }}

GROUP ADDRESSES

{{ calcScope.groups }}

BUS CABLE

~{{ calcScope.cable }} m

Volume applied: hardware and site labour at {{ Math.round(calcScope.volume*100) }}% of unit rate for {{ calcScope.totalDevices }} devices.

WHERE THE MONEY GOES

  • Diagnostic attendance{{ labMoney(calcRepair.diag) }}
  • Bus tracing and telegram analysis{{ labMoney(calcRepair.trace) }}
  • Replacement devices, supplied and refitted{{ labMoney(calcRepair.parts) }}
  • ETS project recovery{{ labMoney(calcRepair.ets) }}

If the fault turns out to be a single loose bus terminal, you pay the attendance and we say so in writing. We would rather lose the invoice than invent a device replacement.

WHERE THE MONEY GOES

  • Tier base cover{{ labMoney(calcMaintain.base) }}
  • Per device on the bus{{ labMoney(calcMaintain.dev) }}
  • Additional preventive visits{{ labMoney(calcMaintain.extraV) }}
  • Additional sites{{ labMoney(calcMaintain.extraS) }}
  • Remote monitoring add-on{{ labMoney(calcMaintain.remote) }}

Every tier includes the offsite ETS and configuration backup. That backup is what stops a future owner paying for a project recovery.

SHARE THESE EXACT FIGURES

The link carries everything you typed. Send it to your architect, your contractor or your spouse and they open the same numbers, not a blank form.

{{ shareMsg }}

Book a site survey instead

Your figures stay in your browser. Nothing is sent until you press the button.

This is a budgeting tool, not a quotation. Hardware uses Malaysian street prices for mid-market KNX brands; labour is built from man-hours costed at Malaysian trade rates and charged out at 2.4 times direct cost. Luminaires, blind and curtain motors, air-conditioning plant, electrical distribution work, network infrastructure and builder works sit outside it. Sources and rates are listed under the labour estimator. The written quote comes after a site survey, and it is the only number we hold ourselves to.

// LABOUR AND MAN-DAY ESTIMATOR

The other half of the number: who does the work, and for how long

Hardware is the part everyone compares. Labour is the part that decides whether the system was actually engineered. This estimator turns your device list into man-hours by trade, costed at published Malaysian wage rates you can edit, and gives you the programme in weeks. It is the same arithmetic a contractor should be doing before quoting you, published openly so you can check theirs.

01 · LEVELS, ZONES AND REPEATS

A repeat unit is an identical layout done again, such as 40 condo units off one type-unit design. Hardware multiplies, the engineering is written once.

02 · SWITCHES AND PANELS

Count the plates on the wall, then the total number of buttons across all of them. A four-gang plate is four buttons.

03 · SENSORS

04 · ACTUATOR AND DIMMER CHANNELS

Count channels, not boxes. One channel drives one lighting circuit, one blind or one valve.

05 · LIGHTING PROTOCOL AND METERING

06 · GATEWAYS AND INTEGRATION

10 · POWER AND TOPOLOGY

These follow from the device count, so they default to auto. Override them only if you already have a design.

07 · GROUPING AND PROGRAMMING

Grouping, scenes and schedules are engineering hours in ETS, not parts on a shelf. They are priced as work.

08 · SITE CONDITIONS AND DELIVERY

09 · WHERE IS THE BUILDING

11 · CREW AND CHARGE-OUT

The multiplier turns what a worker costs you into what a contractor charges for them. It covers site overheads, transport, tools, insurance, non-billable time, risk and profit. Industry practice sits between 2.0 and 2.8; the default here is 2.4.

LABOUR CONTENT

{{ labMoney(labCharged) }}

charged-out labour at {{ labMul }}× direct cost

TOTAL MAN-HOURS

{{ labHrs(labHours) }}

MAN-DAYS

{{ Math.round(labManDays*10)/10 }}

PROGRAMME

{{ labWeeks }} wk

LABOUR PER DEVICE

{{ labMoney(labPerDevice) }}

WORK PACKAGES

  • {{ w.label }} {{ labHrs(w.h) }}

MANPOWER BY TRADE

Rates are employer cost per productive hour, not what you get charged. They are built from Malaysian 2026 monthly pay plus 15% statutory (EPF, SOCSO, EIS) over 150 productive hours a month.

  • {{ r.label }} {{ labMoney(labByRole[r.k]*labRateOf[r.k]) }}
    {{ r.note }} {{ labHrs(labByRole[r.k]) }} @ RM{{ labRateOf[r.k] }}/h

HOW IT ADDS UP

  • Direct manpower cost{{ labMoney(labRaw) }}
  • Charge-out uplift at {{ labMul }}×{{ labMoney(labRaw*labMul-labRaw) }}
  • Travel, lodging and subsistence{{ labMoney(labTravel) }}
  • Charged-out labour{{ labMoney(labCharged) }}
  • Site crew days at {{ lab.crewSite }} on site{{ Math.round(labSiteDays*10)/10 }}
  • Engineering days at {{ lab.crewEng }} programming{{ Math.round(labEngDays*10)/10 }}

SHARE THESE EXACT FIGURES

The link carries every input and every rate you edited. Send it to your contractor and they open the same numbers, not a blank form.

{{ shareMsgL }}

Have us price the labour properly

Why buttons are counted, not plates

Fixing a plate takes minutes. Assigning, engraving, labelling and functionally testing every button on it is where the hours go, and an eight-button plate is four times the work of a two-button one at almost the same hardware price.

Why DALI is priced per luminaire

A DALI gateway is one box, but every fitting behind it has to be individually addressed, grouped and proven. Two hundred luminaires is roughly twenty-four hours of commissioning that no hardware list will show you.

Why repeat units get cheaper

Forty identical condo units are forty sets of hardware but one type-unit design, one group-address schema and one tested logic library. Site labour drops about 14% per repeat through learning; engineering barely moves at all.

WHERE THESE RATES COME FROM

  • National minimum wage RM1,700 a month, RM8.18 an hour, Minimum Wages Order 2024, in force since February 2025 with no remaining exemptions.
  • Electrician RM2,400 to RM4,300 a month on Jobstreet Malaysia; RM2,780 average on Indeed Malaysia.
  • Chargeman RM2,500 to RM5,000 a month; BO chargeman RM6,250 to RM8,750 on Jobstreet Malaysia.
  • Automation engineer RM4,400 to RM6,500 a month on Jobstreet Malaysia; RM5,753 average on Indeed Malaysia.
  • Employer statutory loading: EPF 13% below RM5,000 of wages, SOCSO about 1.75%, EIS 0.2%, taken here as 15%.
  • Hardware anchored on Malaysian street prices, ABB plates around RM200 and Gira around RM800, and on published KNX per-output pricing of about EUR16.60 for ABB and MDT converted at 4.72 ringgit to the euro, plus landed cost and distribution.
  • Malaysian electrical trade context: conventional wiring points run RM80 to RM220 each and hacking and plastering from RM70 a point, which is the labour market these crews are drawn from.

Productivity norms are averages from our own commissioned projects. Ground conditions, drawing quality and how late the electrical contractor finishes will move them. Materials, hardware, scaffold hire, builder works and statutory submissions are not included; this is manpower only. Pair it with the budget calculator for a full picture.

Quantified system benefits

30-40%

Energy Savings

Lower TNB bills from smart HVAC, lighting and load management - measured and reported.

1-touch

Convenience

Scenes, schedules and one-touch control across the whole building.

24/7

Enhanced Security

Integrated alarms, presence simulation and instant alerts.

+10-20%

Asset Value

KNX is built-in infrastructure that lifts resale and tenant appeal.

Hit your energy & ESG targets - with the data to prove it

Owners and tenants increasingly demand measurable sustainability. KNX gives you the control to cut consumption and the data to evidence it for green-building and ESG reporting.

Carbon reduction

Lower kWh from smart HVAC, lighting and load management directly cuts Scope 2 emissions.

Measured & verified

Sub-metering and logging give auditable figures - no estimates, real meter data.

Green-building support

Control & monitoring evidence that supports GBI, GreenRE and LEED-style submissions.

ESG-ready reporting

Automated energy & efficiency reports your management can drop straight into ESG disclosures.

Turn “we should save energy” into a number on a report

We baseline your current consumption, tune the system, and deliver a before/after that stands up in a board meeting.

Start an energy baseline
Green-rated Malaysian office tower with deep shading fins and planted sky terraces at golden hour

Rating tools ask for evidence, not intent.

Rooftop solar photovoltaic array on a Malaysian commercial building at sunrise

Generation is only half of it. The other half is when loads run.

Built to support Malaysia’s green & energy rules

KNX gives you the control and the metered data that Malaysian energy regulations, green-building rating tools and tax incentives increasingly ask for. We help you turn compliance into savings.

MS 1525

Malaysian Standard for energy efficiency in non-residential buildings. KNX lighting, HVAC scheduling and sub-metering directly support its targets.

Energy Commission (ST) · EMEER 2008

Large buildings (≥3,000,000 kWh over 6 months) must appoint a registered Electrical Energy Manager. KNX delivers the sub-metered consumption data they report on.

GBI & GreenRE

Malaysia’s green-building rating tools award credits for energy management and controls - KNX monitoring and automation contribute evidence.

GITA · MyHIJAU (MIDA)

Green Investment Tax Allowance supports qualifying green assets. Smart energy-management systems may be eligible - subject to MIDA/MyHIJAU listing and tax advice.

Low Carbon Cities 2030 (LCCF)

GreenTech Malaysia’s framework pushes buildings to cut carbon. KNX gives measurable reductions that count toward city targets.

UBBL & demand management

Better load and Maximum-Demand management helps you stay efficient under TNB commercial tariffs and local by-law expectations.

Programme names and thresholds are provided for general guidance only; eligibility and current requirements should be confirmed with the relevant Malaysian authority or a qualified advisor.

Tailored for Malaysia’s climate & lifestyle

Engineered for our weather, our buildings and how Malaysians actually live and work.

Climate optimisation

  • Tropical heat management: AC adapts to outdoor temperature & humidity (28-35°C, 70-90% RH) typical of KL, JB and Penang.
  • Monsoon protection: rain sensors close windows and retract awnings during sudden downpours.
  • Natural ventilation: smart window logic maximises cool morning/evening airflow, cutting AC dependency.

Malaysian lifestyle integration

  • Prayer-time integration: auto-dim at Maghrib, schedule lighting for Subuh - compatible with local azan timings.
  • Kitchen ventilation: smart exhaust for heavy local cooking, auto-activated on heat/smoke.
  • Security focus: guardhouse, auto-gate and CCTV integration common in gated communities; panic-button alerts.
  • Festive modes: pre-set scenes for Raya, CNY and Deepavali open-house events.
Malaysian home lit for an open house with a warm festive lighting scene

Open-house scene, one button

Low-level night path lighting and a large tactile wall plate in an accessible Malaysian home

Night path for older residents

Why Malaysians choose us

Monsoon-ready

Systems built for tropical weather & power conditions.

Hacking-free options

Wireless KNX RF for occupied buildings.

Cultural fit

Prayer, festive and family-friendly logic.

The “Peter Teh” guarantee

  • Honest, right-sized quotes
  • No vendor lock-in, ever
  • Full documentation & handover
  • 5-year workmanship warranty
  • You reach the engineer directly
Monsoon downpour sweeping across the Kuala Lumpur skyline in the late afternoon

Design for the afternoon storm, not the brochure weather.

Rain and wind sensors retract shading and close vents before the building takes water.

The data behind a tropical building

Malaysia’s heat, humidity and electricity tariffs make automation pay faster here than in temperate climates. Pick a city to see the local picture - and where KNX claws back cost.

up to 60%

of a building’s electricity goes to air-conditioning

30-40%

energy typically recoverable with KNX control

25-35°C

year-round temperature, 70-90% humidity

~RM40 / kW

typical TNB Maximum-Demand charge

SELECTED CITY

{{ myC.name }}

{{ myC.type }}

AVG HIGH

{{ myC.hi }}°C

HUMIDITY

{{ myC.rh }}%

RAINFALL

{{ myC.rain }} mm

SUN HOURS

{{ myC.sun }} /day

COOLING DEMAND INTENSITY

{{ myC.cool }}/100 - higher heat & humidity means more AC runtime KNX can optimise.

KNX OPPORTUNITY

{{ myC.note }}

// Climate figures are typical annual averages for general guidance.

// TNB MAXIMUM DEMAND

Shave the peak, shrink the bill

Malaysian commercial tariffs charge for your highest 30-minute demand (kW) - not just energy used. KNX staggers start-ups and sheds non-essential loads to flatten that peak. Toggle KNX below to see the effect.

Without KNX
With KNX peak-shaving

PEAK DEMAND

{{ mdPeak }} kW

EST. MD SAVING

RM {{ mdSaving.toLocaleString() }}/mo

Daily load profile (kW)

{{ md.shaved?'capped at '+mdCap+' kW':'uncontrolled' }}
{{ t }}

Official KNX certified brands we work with

ABBSiemensSchneiderGiraMDTThebenJungHagerZennioBerker

500+ manufacturers build to the KNX standard - we choose hardware on merit and price, never on lock-in.

Eight control modules from different manufacturers linked by a single continuous KNX bus cable

Eight manufacturers. One bus cable. That is the entire argument for an open standard.

Peter Teh (Teh Hon Kee), KNX-certified building automation engineer, Malaysia
// LEAD INTEGRATOR

Peter Teh, and why there is only one name on this site

A developer, an architect and a consultant do not want a salesperson between them and the system. They want the engineer who can stand at the distribution board, read the bus with a laptop and say plainly what is wrong, what it costs and what it will do in year seven. Peter Teh (Teh Hon Kee) has done exactly that on Malaysian projects since 2014, certified by the KNX Association and still on site most weeks.

There is one name on this site because there is one person accountable for the engineering. Design decisions, ETS project, commissioning and the phone number you call at 9pm all belong to the same engineer. Larger installations are delivered with a trained site crew, but the design and the programming never get handed to a subcontractor you have never met.

524+
Projects commissioned
55
Project types
2014
Certified since

Design and programming

Held by Peter on every project. Topology, ETS engineering and commissioning are never subcontracted out.

Installation crew

Trained wiremen and panel builders who work to our labelling, containment and segregation standard, project after project.

Specialist partners

Lighting designers, DALI and AV suppliers and the client's own electrical contractor, coordinated under one scope of works.

What the people who signed off the work say

“The per-unit test sheets are what won us over. When a defect came in during DLP we could tell in a minute whether it was the device, the wiring or the tenant.”

Y

Yeoh Wei Sheng

Project director, residential developer

“He gave us a plate schedule and sensor positions early enough to put into the drawings. Nothing had to be resolved on site in front of the client.”

N

Nurul Hidayah Zainal

Principal architect

“The topology and loading calculations came with the margin stated. I could put my name on the submission without redrawing anything.”

R

Ravindran Sagadevan

Senior M&E consultant

“They took over an orphaned system, recovered the programming and now hold our maintenance contract. Faults that used to take days close the same day.”

C

Chong Kah Wai

Facilities manager, KL office tower

“The energy report showed exactly which floors were burning power after hours. That single finding paid for the first year of the contract.”

M

Melissa Tan

Operations lead, multi-tenant office

“Floor by floor, with the hotel still trading. Vacant-room set-back showed up on the bill by the second month.”

L

Lim Sze Ying

General manager, boutique hotel

“Industrial-grade engineering at a Malaysian price. The prayer-time and festive scenes matter more to the family than I expected.”

D

Dato Ahmad Faizal

Owner, bungalow, Shah Alam

“Wireless retrofit with no wall hacking. My finishes were untouched, exactly as promised at the survey.”

A

Alicia Wong

Owner, semi-D retrofit, PJ

“Reliable, low maintenance, and when I message on a Sunday the person replying is the engineer who built it.”

D

Dr Liew Poh San

Specialist clinic, Penang

Where we work across Malaysia

Based in Kuala Lumpur, serving nationwide. Klang Valley gets same/next-day response; other regions on a scheduled or project basis.

Primary - Klang Valley

Kuala Lumpur, Petaling Jaya, Subang Jaya, Shah Alam, Puchong, Cyberjaya, Klang

Same / next-day response

Secondary - nationwide

Johor Bahru, Penang, Ipoh, Melaka, Seremban, Kuantan

Scheduled & priority visits

Extended - East Malaysia

Sabah & Sarawak (Kota Kinabalu, Kuching)

Project basis, min. value applies

Kuala LumpurSelangorPetaling JayaSubang JayaShah AlamPuchongCyberjayaKlangJohor BahruPenangIpohMelakaSerembanKuantanKota KinabaluKuching
Dusk aerial across a Malaysian urban corridor of high-rise towers, highways, shophouses and industrial sheds

Klang Valley same or next day. The rest of the peninsula on schedule.

Sabah and Sarawak on a project basis, where the travel is priced honestly up front.

The questions developers, architects and consultants actually ask

How many man-hours does a KNX installation actually take?

More than most quotations admit, and the split matters more than the total. A double-storey terrace of roughly 34 bus devices runs about 143 man-hours, or 18 man-days over two weeks; a three-storey bungalow of about 69 devices runs roughly 268 man-hours over three weeks. The split is consistently around 40% first-fix containment and cable, 20% panel build and termination, 15% ETS engineering, 10% commissioning and witnessed testing, and the balance in device fixing, supervision and handover documentation. The labour estimator at #labour lets you run your own numbers at your own rates. Charged-out labour usually lands between RM330 and RM620 per device, higher on small jobs because the fixed engineering does not shrink. Watch the programme too: a crew that promises a 70-device house in four days is not testing anything.

Can I work out my own KNX cost before contacting anyone?

Yes. The budget calculator at #calculator gives you an indicative range in the browser, and nothing is sent to us until you press the button. Count what you can actually see: the switch plates on the wall, the total number of buttons across all of them, touchscreen panels, sensors by type, and the number of circuits you want switched, dimmed, motorised or valve-controlled. You are not asked for power supplies, line couplers or DALI gateways, because those are worked out from the device count - a KNX line carries 64 devices, a DALI gateway carries 64 addresses, and no client should have to guess that. Hardware is priced at Malaysian street rates for mid-market KNX brands and labour is built from man-hours costed at published Malaysian trade wages, so the figure is auditable rather than a guess. Repair and maintenance use different models, since a fault-finding visit is priced on how much of the bus we trace and replace, and a contract is priced on what has to be kept alive. You can copy a link that carries everything you typed and send it to your architect or contractor, who will open the same figures. It is a budgeting range, not a quotation; the written quote follows a site survey.

How much does a KNX system cost in Malaysia?

It scales with the number of controlled points, not with the size of the brochure. A condominium package starts around RM14,888 for lighting, air-conditioning control, app access and smart plates. Link houses typically land between RM22,000 and RM32,000, boutique offices between RM30,000 and RM50,000. Towers, estates and bulk residential rollouts are phased and quoted on measured scope. Whatever the figure, the engineering standard behind it does not change. Most of our work sits below RM100,000 - 388 projects of the 524 on the record - so a budget in that range is our normal day, not an exception we squeeze in.

Can I get a real KNX system for under RM100,000 in Malaysia?

Yes, and it is the single largest part of our record: 388 of 524 commissioned projects were contracted below RM100,000, at a median of about RM38,400. Entry packages for a single condominium unit start at RM14,888, a whole double-storey terrace house typically lands between RM24,000 and RM45,000, and a small commercial floor or community building between RM70,000 and RM100,000. Nothing is removed from the engineering to hit those figures - the topology margin, labelling, ETS project handover, witnessed testing and documentation are identical to a seven-figure job. What changes is device count and design hours, because we work from pre-engineered panel blocks, a fixed group-address schema and a tested logic library instead of drawing every small project from a blank page.

Why do other KNX integrators quote so much more for a small house?

Because a KNX project below RM100,000 carries almost the same design, programming and commissioning overhead as one ten times larger - only the device count is smaller. An integrator whose smallest normal job is a hotel prices that overhead as a fixed cost, which is how a terrace house ends up quoted at RM70,000. We have spent twelve years engineering that overhead down: reusable panel blocks, one addressing standard across every project, a stocked device shortlist and one accountable engineer with no sales or coordination layer in between. The saving comes out of process, never out of the system.

What is the smallest KNX project you will take on?

About RM15,000. Below that, the fixed cost of surveying, programming, commissioning and documenting a system properly consumes the entire budget, and the only way to deliver it is to skip one of those steps - which we will not do. If your scope is a single room, we will tell you it does not need a bus rather than sell you one.

Is a cheap KNX system worse than an expensive one?

It is smaller, not weaker - provided nothing was removed from the engineering. The parts that must never be cut are topology margin, power-supply headroom, labelling and containment, the ETS project file handed to you, witnessed per-circuit testing and the handover pack. If a quotation you are comparing does not name those, it is not cheaper than a proper one; it is a smaller scope described as the same thing. Ask any integrator to attach a points list and the two proposals become comparable in minutes.

Should I just buy Wi-Fi smart switches instead of KNX for my house?

If you are renting and leaving in two years, sometimes yes, honestly. If you are wiring a home once, you are choosing between a closed cloud product with a typical commercial life of around four years and an international standard with certified devices from more than 500 manufacturers and no dependence on any single one surviving. The cost of being wrong is not the price difference - it is a wall you have already closed up.

Do I need to hack walls for KNX installation?

Not necessarily. New builds and renovations use wired KNX twisted-pair (most robust). For existing/occupied buildings we use KNX RF wireless, adding intelligence without wall-hacking.

What happens if the internet goes down - will lights stop working?

No. KNX runs on a local wired bus. Switches, sensors and schedules keep working with no internet. Internet is only needed for remote app control when away.

Can KNX control my air conditioners?

Yes - split units (Daikin, Panasonic, Mitsubishi) via IR/gateways, VRV/VRF central systems via gateways, and FCUs via valve actuators.

How long is the warranty and what does it cover?

We provide a 5-year workmanship warranty on programming, installation and integration. Hardware carries 1-2 year manufacturer warranties depending on brand.

Is KNX difficult to use if I am not tech-savvy?

No. Physical switches work normally; apps are organised by room/zone; voice works in English, Malay and Mandarin. Most occupants - including elderly family - adapt in 2-3 days.

Can I expand the system later, or am I locked in?

KNX is infinitely expandable as an open standard. Add devices, mix 500+ brands, extend to new areas - and any certified integrator can modify it.

How long does installation take and will the building be in chaos?

Condo: 3-7 days. Link/terrace: 2-3 weeks. Semi-D/bungalow: 3-4 weeks. Wireless retrofit: 5-10 days. Buildings are phased floor-by-floor to minimise disruption.

What about cybersecurity - can hackers control the building?

KNX is far more secure than cloud WiFi gadgets: no cloud dependency, wired communication, no default passwords and AES-128 options. Data stays local.

Will KNX increase my property value in Malaysia?

Yes - properties with KNX can see 10-20% higher resale value and sell faster, because it is seen as built-in infrastructure, not disposable gadgets.

Do you service areas outside the Klang Valley?

Yes - KL, Selangor, Johor Bahru, Penang, Ipoh, Melaka, Seremban, plus Sabah/Sarawak on a project basis (minimum project value applies).

What if a KNX device fails after 5 years - can I still get parts?

Yes. KNX is a long-life open standard; replacement devices from many brands remain available and interoperable. We hold the ETS project so swaps are quick.

Can I DIY install KNX to save money?

You can buy devices, but ETS programming, topology and commissioning need expertise. A first DIY attempt typically takes 3-4× longer and risks an unreliable result. Most owners save more by getting it right once.

What is the difference between KNX and Loxone / Control4 / Crestron?

KNX is a vendor-neutral international standard with 500+ interoperable brands - no single-vendor lock-in. Loxone/Control4/Crestron are proprietary ecosystems tied to one manufacturer.

I am renting - can I still install KNX?

Wireless KNX RF can be installed and later removed/relocated, subject to landlord consent. For permanent buildings, wired KNX is recommended.

Do I need permits/approvals from MBPJ/DBKL?

For typical fit-outs, no special automation permit is needed; standard electrical works follow normal wiring regulations. New builds follow the project’s M&E approvals.

How does KNX handle Malaysia’s power outages and voltage fluctuations?

KNX bus power supplies are robust; we add surge protection and the bus resumes normal operation after outages. Critical logic survives because it is local, not cloud.

Can KNX integrate with existing CCTV, alarm or auto-gate?

Yes - Hikvision/Dahua CCTV, DSC/Paradox/Honeywell alarms, auto-gates, smart locks and video doorbells via integration gateways.

What about warranty if I buy a property with KNX installed by the previous owner?

Ask for the ETS backup file, device list, wiring diagrams and warranty certificate. We offer pre-purchase KNX inspection and can take over and re-document the system.

Can I control KNX with Siri / Apple HomeKit?

Yes - via native KNX-HomeKit gateways or Homebridge. KNX devices appear as native HomeKit accessories for Siri control.

Can I really mix different brands (e.g. ABB switch + Hager actuator)?

Yes - that is the core advantage of KNX. All certified devices speak the same protocol and interoperate seamlessly.

What if my original installer goes missing (orphaned system)?

This is a core service. We read the live bus, recover or rebuild the ETS project and group addresses, document everything and take over maintenance - you are never locked to one installer.

Do you offer maintenance contracts with an SLA for buildings?

Yes - scheduled servicing, bus health checks, ETS backups, firmware reviews and guaranteed response times (typically under 4 hours for contract clients, with 24/7 emergency cover).

Can the system give me analytics and reports for management decisions?

Yes. KNX with a visualisation/energy server provides dashboards, energy and occupancy trends, sub-metered cost allocation, anomaly insights and exportable reports to support operations and capital decisions.

Can KNX integrate with our existing BMS via BACnet/Modbus?

Yes - certified BACnet/IP and Modbus TCP/RTU gateways let KNX work alongside or feed an existing supervisory BMS, so you integrate rather than rip-and-replace.

We are a developer. Can you handle a multi-block rollout unit by unit?

Yes. Bulk residential rollouts are run as a repeatable unit template: one type-unit is designed, programmed and signed off, then replicated per unit with a per-unit ETS sub-project, serialised device schedule and a per-unit test sheet. Blocks are released floor by floor to follow your handover programme, and the whole package lands with JMB-ready documentation.

Can you write the KNX section of our tender specification?

Yes, and it costs you nothing to have it drafted. We supply a vendor-neutral clause set (scope, topology, device performance, labelling, testing and commissioning, documentation and training) plus an indicative points list and BQ structure. It is written so at least three certified integrators can price it like for like, not so it points back at us.

What do architects actually have to decide, and when?

Three things, early: switch-plate family and finish (affects wall build-up and back-box depth), the control philosophy per room (how many scenes, what each plate does), and ceiling coordination for presence and lux sensors on the RCP. We give you a plate schedule, symbol block for your drawings and a per-room control narrative so the decisions sit inside your normal drawing set.

What do you hand over to the M&E consultant during design?

Bus topology and line-loading calculations, power-supply sizing, riser and containment requirements, DB and panel layouts with device schedules, group-address structure, an interface points list for BACnet/Modbus/DALI, and a testing and commissioning method statement. All in formats you can attach to your submission.

How do you handle the defect liability period on a developer project?

Every unit or zone is handed over with a signed test sheet and a photographic record of the panel. During DLP, faults are logged against that record so the cause is clear - installation, device or third-party works. We keep the ETS project and can attend site on an agreed response time rather than a scramble to find whoever wired it.

Will the system survive the transition from developer to JMB or MC?

That is exactly what the documentation pack is for. The JMB receives the as-built drawings, group-address list, panel schedules, ETS backup, device inventory with warranty dates, an operating guide and a training session. Because KNX is an open standard, they can appoint any certified integrator afterwards - including keeping us on a maintenance contract.

How does KNX help us hit MS 1525 and green-building credits on a submission?

MS 1525 asks for lighting zoning, daylight and occupancy control, and metering. KNX delivers all of it natively and, more usefully, logs it - so what you claimed at design stage can be evidenced with real metered data at verification. The same data supports GBI, GreenRE and LEED-style energy-management credits.

We already appointed a main electrical contractor. Where do you fit?

Usually as the specialist automation package under the electrical contractor or direct to the developer, depending on procurement. We provide the containment, cable and back-box requirements for them to install, then take over from termination onward: device installation, ETS programming, commissioning, testing and handover. Split of scope is agreed in writing before site works begin.

Book a design review

Send the drawings, the problem, or just the building type. Peter replies with the right next step: a design-stage review, a site survey, a diagnostic call-out or a scoped quotation. Response within one working day.

Talk to the engineer directly

Peter Teh (Teh Hon Kee)

Lead KNX Integrator

Phone / WhatsApp

+6016-531 3713

Based in

Kuala Lumpur · serving all Malaysia

Hours

Mon-Fri 9:00-18:00 · Sat 10:00-15:00

24/7 emergency for contract clients

Send your enquiry

By submitting you agree to be contacted about your enquiry. Your details are not shared with third parties.

Free Consultation

No-obligation site visit & quote within the Klang Valley.

Quick Response

We typically respond within 2-4 hours in business hours.

Detailed Quote

Itemised quotation with device specs within 3-5 days.

Engineer and client reviewing an open distribution board and drawings during a site survey

A design review costs you nothing and usually saves a redesign.

Bring drawings, a photo of the panel, or just the building type.
